PREMIX FEED MILL
The specification decisions made when designing a premix feed mill are different from almost any other feed processing line — and buyers who’ve tried to adapt a standard feed plant for premix production usually figure that out the hard way. The equipment list isn’t dramatically longer than a conventional feed line, but the tolerance requirements at each stage are tighter.
Equipment that contacts the materials directly — dosing scales, mixing chambers, screw conveyors, discharge valves — is typically built from 304 or 316L stainless steel in most serious installations. That said, full stainless-steel lines exist but aren’t the standard; the more practical approach, and what most premix factories actually run, is a carbon steel structural frame with stainless contact surfaces. We’ve built both configurations, and the decision usually comes down to the product category, the target market’s regulatory expectations, and what the client’s accountant says.
RICHI has engineered premix feed production lines for compound feed manufacturers, integrated livestock farms, dedicated premix factories, and agricultural cooperatives across Southeast Asia, South Asia, Africa, the Middle East, and Latin America.
The product scope covers poultry premix (broiler, layer, breeder), pig premix (starter, grower, sow), ruminant premix (cattle, sheep, goat), aquatic premix (shrimp, fish), and specialty additive blends — vitamin premix, mineral premix, and multi-component feed additive premixes that require sequenced micro-dosing before the main blend. Each line is configured differently. Output scale, ingredient complexity, the number of micro-dosing stations, automation level, and facility layout all affect how the system is designed. There’s no single standard configuration that works for everyone.
Tell Us About Your Premix Project
What Types of Premix Can Your Line Process?
Premix isn’t one product — it’s a category that covers five technically distinct formulation types, each with different ingredient ratios, carrier materials, moisture sensitivities, and downstream handling requirements. The equipment configuration that works cleanly for a vitamin premix won’t necessarily handle a mineral-heavy compound premix without adjustment. Before specifying a line, it’s worth being clear about which of these you’re actually producing.

Vitamin Premix
Carrier-dependent and hygroscopic by nature — rice bran and limestone powder are the most common bases, and both behave differently under the same dosing conditions. Vitamin stability during mixing is the primary concern here; extended mix cycles or heat buildup from friction will degrade fat-soluble vitamins faster than most buyers expect. Our micro-dosing systems and low-shear mixers are configured specifically to handle these sensitivities.
Powder, 0.1–0.5mm particle size

Mineral / Trace Element Premix
Copper, iron, zinc, manganese, selenium — the bulk density variation across these raw materials alone creates headaches at the batching stage. Segregation during transfer is a real issue if the conveying system isn’t matched to the particle size distribution. Equipment in direct contact with mineral ingredients, particularly anything handling selenium or copper sulfate concentrations, requires 304 stainless steel at minimum.
Granular or fine powder, 0.2–1.0mm

Compound Premix (Vitamins & Minerals & Amino Acids)
The most common premix type in commercial production — and the most demanding to batch accurately, since it combines ingredients from all three of the other categories. A compound premix line needs more dosing stations, tighter scale resolution (typically ±0.1g at micro-ingredient level), and a mixer that handles both fine powders and coarser mineral particles without creating dead zones where residue accumulates between batches.
Powder or micro-granule, 0.2–0.8mm

Medicated & Functional Premix
Coccidiostats, enzyme preparations, probiotic blends — these ingredients are often active at very low inclusion rates, sometimes below 50g per ton of finished premix. Cross-contamination between batches isn’t just a quality issue here; in regulated markets it’s a compliance failure. Dedicated flushing sequences, cleanout access panels, and batch traceability integration are standard on lines built for this category.
Fine powder, typically <0.3mm

Amino Acid Premix (Lysine, Methionine-based)
These lines run leaner on equipment — amino acid premixes carry little or no inert carrier, which simplifies batching but puts more load on the accuracy of the dosing system itself. Lysine HCl and DL-methionine have very different flow characteristics; a system calibrated for one will drift on the other if the software doesn’t account for bulk density shifts during a production run.
Granular, 0.5–2.0mm
A premix feed mill we design can be configured to run powder and pellet outputs on the same line, switch between premix and complete feed formulations, or handle both poultry premix and aquatic premix in the same production shift with changeover protocols built in.
Discuss a Multi-Format Line Configuration
Premix Feed Mill plant videos
Over the years we’ve commissioned premix feed production lines across six continents, in climates ranging from Central Asian winters to Southeast Asian humidity, for clients running everything from single-product vitamin premix batches to complex multi-species compound premix operations.
A selection of documented project videos is below. These aren’t showroom demos — they’re running production lines, filmed on-site after commissioning.
From Process Layout to Commissioned Line
No two premix lines we’ve built have had identical process configurations — and that’s not a sales pitch, it’s just the reality of what premix manufacturing involves. What we provide isn’t just equipment — it’s the process engineering that makes the equipment work together. That means working through the client’s formulation list before anything is specified, understanding which raw materials create handling problems, identifying where cross-contamination risk sits in the process flow, and designing around the building constraints rather than asking the client to build around the equipment.
We cover the full project scope: process design, mechanical engineering, manufacturing, factory acceptance testing, site installation, commissioning, operator training, and spare parts support. That support doesn’t end at handover. For clients running 24-hour production, access to technical assistance and parts availability over the life of the line matters more than most buyers factor in when comparing initial quotes.

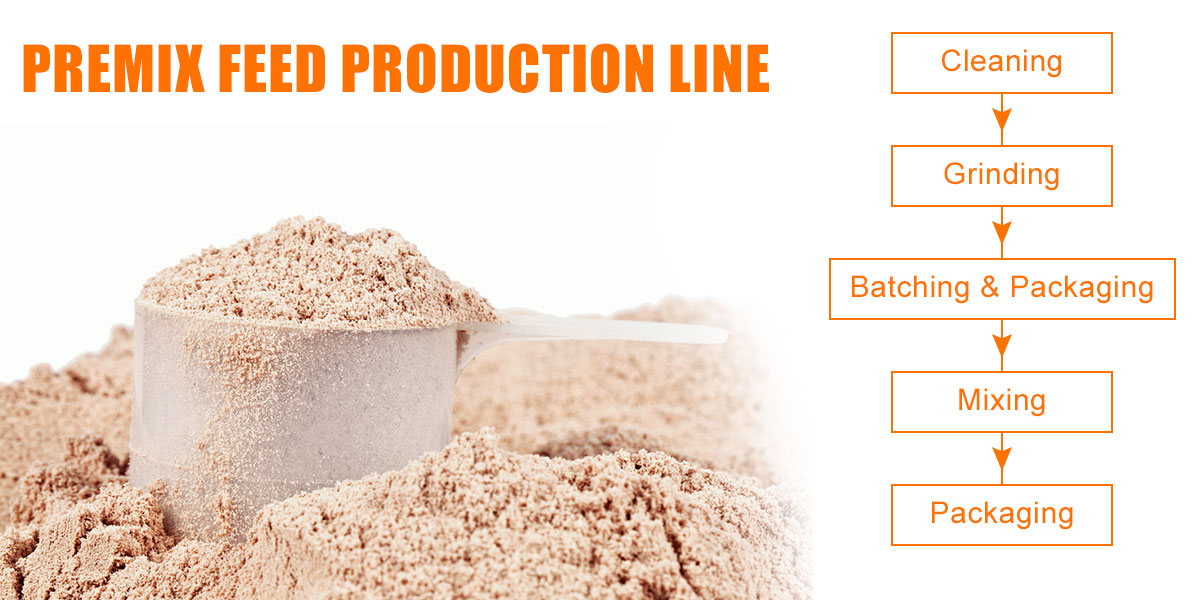

A complete premix feed mill typically runs through the following process stages: raw material receiving and pre-cleaning, bulk ingredient storage and handling, batching and weighing (both macro and micro scale), liquid addition where required, primary mixing, secondary mixing or re-blending for complex formulations, packaging, dust collection, and pneumatic or mechanical conveying between stages.
sizes below 150 microns), multi-tier micro-ingredient addition systems, pre-blending of small-volume additives before they enter the main mixer, anti-bridging and flow-aid systems for problematic raw materials, low-temperature mixing protocols for heat-sensitive vitamin compounds, and automated sampling with inline quality monitoring. Some of these are standard on most lines we build. Others are genuinely optional and depend entirely on what the client is producing and to what specification.

Silo system
01

Screening system
02

Grinding system
03

Mixing system
04

Cleaning system
05

Cooling system
06

Packaging system
07

Dust removal system
08

Conveying system
9
customized Premix Feed Mill Process Design Schemes
Every premix feed mill process design on this page was built around a specific client’s raw materials, building constraints, production targets, and budget — not adapted from a template. The four schemes below cover a range of scenarios: fully automatic high-spec dedicated premix lines, combined premix and complete feed operations, all-stainless low-ceiling installations, and retrofit integrations into existing facilities. Capacity ranges from 3 t/h to 10 t/h. Each one looks different because the problems being solved were different.
Global Premix Feed Mill Projects
Across more than 80 countries, we’ve delivered premix feed mill projects for compound feed manufacturers, integrated livestock operations, commercial premix producers, and agricultural cooperatives — at scales ranging from 1 t/h pilot installations to 40 t/h industrial facilities.
The projects below represent a cross-section of what we’ve built: single-product premix lines, multi-species premix operations, and combined plants where premix production runs alongside pellet feed, mash feed, or extruded aqua feed lines on the same site. Formulation complexity varies as much as output scale does — some clients run 3 SKUs, others manage 30+. What stays consistent is that each line was engineered around the client’s actual raw materials, building constraints, and production targets, not adapted from a template.
Clients who’ve run their premix feed mill through a full production season tend to have very specific things to say — about what worked, what surprised them, and where the equipment held up under pressure. A few of them said it better than we could.

What Does a Premix Feed Mill Actually Cost to Build?
The question comes up in almost every early conversation: what’s the budget? The honest answer is that premix feed production lines vary more in cost than almost any other feed processing category — because the range of what qualifies as a “premix line” spans from a semi-automatic 1 t/h mixing unit to a fully automated 30 t/h industrial facility with multi-floor layout, stainless steel throughout, and ERP integration. The figures below are drawn from real project data and split into two parts: the equipment investment (what we supply) and the additional costs you’ll need to budget for independently to get the facility operational.
Complete premix feed plant set up investment : $30,000 – $3,000,000
Equipment Investment :
Raw Material Receiving & Pre-Cleaning Equipment price :
$3,500–$25,000
Bulk Ingredient Storage & Handling Equipment Price :
$4,500-$60,000
Batching & Macro-Weighing System Price :
$3,000–$45,000

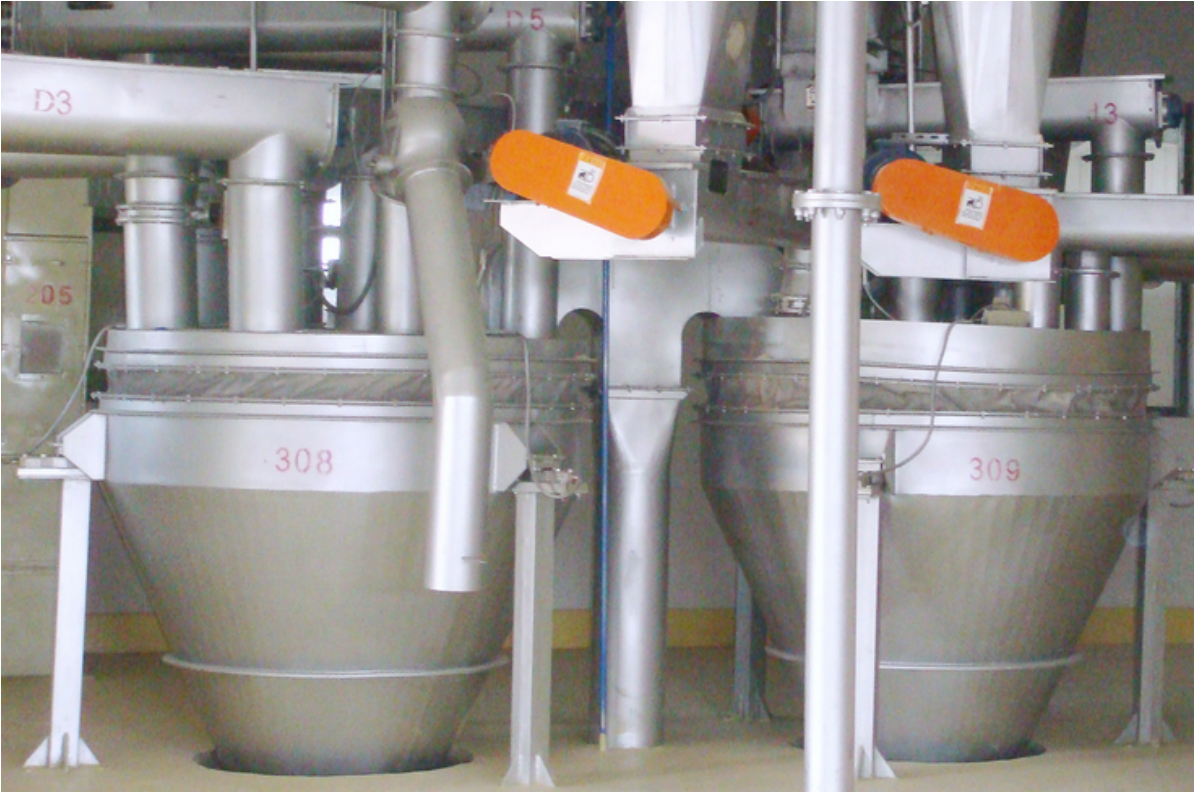

Micro-Ingredient Dosing System Price :
$1,500–$120,000
Grinding / Ultra-Fine Milling Equipment Price :
$4,000–$185,000
Premix Mixer Price :
$3,000–$80,000
Liquid Addition System Equipment Price :
$2,500–$30,000
Conveying System (Pneumatic & Mechanical) Price :
$10,000-$55,000
Packaging Equipment price :
$5,000-$50,000
Dust Collection & Ventilation systems Price :
$3,000-$30,000
Electrical Control System (PLC/SCADA) Price :
$8,000 – $60,000
These ranges come from over 1,000 completed projects across more than 80 countries — not from theoretical estimates. The spread is wide because the variables genuinely are wide: a 1 t/h semi-automatic vitamin premix line built inside an existing farm building in a low-cost market is a fundamentally different investment from a 15 t/h automated compound premix facility built to GMP+ standard in Western Europe. Both are premix feed mill projects. The investment profile is almost incomparable.
What the ranges above won’t tell you is what your specific project will actually cost — because that depends on your output target, your formulation list, your building situation, your local construction market, and the automation level that makes sense for your operation. The most useful thing we can do at this stage is work through those variables with you directly, put together an equipment specification matched to your actual requirements, and give you a real number rather than a range. If you’re at the point of evaluating whether this investment makes sense for your business — production scale, payback period, market demand — that’s a conversation we can have too.

From First Drawing to Final Batch
Building a premix feed mill involves more moving parts than most buyers account for in the early stages — process engineering, civil layout, equipment specification, installation sequencing, operator readiness, and long-term parts availability all have to come together for the line to actually perform as designed. RICHI manages every stage of that process, with in-house capability across design, manufacturing, installation, and post-commissioning support. No subcontracting the critical work out to third parties.

Process Design & Custom Engineering
Every project starts from your raw materials, building conditions, and production targets — not a standard template. We design full process flow, layout, civil recommendations, and equipment configuration before manufacturing begins. Special requirements such as limited ceiling height, structural columns, or difficult-flow materials (hygroscopic powders, abrasive minerals, micro-additives) are considered in the design stage, not as afterthoughts. All layouts and non-standard configurations are engineered in-house.

Equipment Manufacturing
All equipment is produced in RICHI’s 330,000 m² manufacturing facility with integrated fabrication, machining, welding, and assembly lines. Our production covers structural steel, stainless components, dosing systems, and electrical control cabinets. The factory is ISO, CE, and SGS certified, and equipment is exported to 80+ countries. Clients are welcome to inspect production and testing before shipment.

Installation, Commissioning & Training
RICHI engineers supervise overseas installation and commissioning directly. The process includes mechanical assembly, electrical verification, system testing, and trial production using client materials. Operator training is conducted on-site during live commissioning, supported with documentation in the client’s working language where possible.

After-Sales & Lifecycle Support
We provide long-term spare parts support across the equipment lifecycle (typically 15–20 years). Remote technical assistance is available for troubleshooting and optimization. Follow-ups are conducted at 3 and 12 months after commissioning, and project records are retained for future expansion or upgrades.
Free Technical Support Before You Spend a Dollar
Most equipment suppliers ask you to commit to a purchase before they’ll show you anything useful. We work differently. Before any contract is signed, we put real engineering resources into understanding your project — and everything produced during that phase costs you nothing. For any client seriously evaluating a premix feed mill investment, the following services are provided at no charge, with no obligation attached.

Free Project Cost Estimate & Equipment List

Free Process Flow Chart Design

Free 3D Plant Rendering & Layout Design

Free Three-View Engineering Drawings & Civil Drawings

Free Electrical & Circuit Diagram Design

Free Factory Area Planning

Free Production Trial & Testing

Free Lifetime Remote Support, Operation Guidance & Staff Training
Equipment That Runs a Premix Line
A complete premix production line draws from the following equipment categories — raw material receiving and intake systems, pre-cleaning and screening equipment, bulk ingredient storage bins and silos, grinding and ultra-fine milling machines, macro batching and weighing systems, micro-ingredient dosing units (4 to 20+ stations depending on formulation complexity), liquid addition systems, primary mixers, secondary re-blending mixers where required, pneumatic and mechanical conveying systems, packaging machines (bag filling, sealing, and weighing), dust collection and filtration systems, and full electrical control systems.
Pre-blending units for small-volume additives and anti-bridging flow-aid systems for difficult raw materials are available as optional modules depending on the ingredient profile.
Premix production puts specific demands on equipment that standard feed mill machinery simply isn’t built for. The industry-standard solution isn’t to build everything in stainless — that drives up capital cost significantly — but to apply a “carbon steel structure, stainless contact surface” approach. Most premix feed mill installations we’ve commissioned follow this configuration. Full stainless-steel lines are available and make sense for clients operating under GMP+ or pharmaceutical-grade regulatory requirements, but they’re not the default.

premix mixer machine

batching scale

batching & weighing system

Liquid addition system
Explore the full equipment catalog for premix feed production lines, or ask us directly about specifications and lead times for your configuration.
Why Premix Production Is Worth Looking at Right Now
The structural demand for premix isn’t going away — and in most markets it’s growing, not plateauing. As livestock production intensifies and biosecurity standards tighten, the gap between farms that use precisely formulated premix and those that don’t shows up directly in feed conversion ratios, mortality rates, and ultimately in the economics of the operation.
The more interesting question for most serious investors isn’t whether premix production is viable — it’s how to structure it for maximum return. Single-product vitamin premix lines have lower capital requirements but narrower margins and more exposure to raw material price swings. Compound premix lines serving multiple species (poultry, swine, ruminant, aquaculture) generate better margin per ton but require more sophisticated batching systems and more careful formulation management.
The highest-margin configurations we see are combined facilities: a premix unit feeding an on-site complete feed production line, capturing value at both stages of the supply chain. Some clients also run their premix line at 120–150% of internal demand, selling the surplus to neighboring farms or smaller feed producers — turning what started as a cost-reduction project into a revenue line.
The direction this market is heading — tighter feed safety regulation, more species-specific nutrition requirements, growing resistance to imported premix dependency in many countries — all points toward more localized premix manufacturing, not less. Whether that means a 1 t/h farm-scale unit or a 15 t/h regional supply operation depends entirely on where you’re positioned. Both have worked. The difference is in how well the investment is matched to the actual demand structure in your market.
Talk to Us About Starting a Premix Feed Business
Premix Feed Raw Materials, Feed Types & Reference Formulas
The raw material profile of a premix batch determines almost everything downstream — how the ingredients flow through dosing equipment, how the mixer handles bulk density variation, how long the blend stays homogeneous before segregation becomes a problem. Standard premix raw materials include vitamins (A, D3, E, K3, B-complex series), trace minerals (copper sulfate, zinc oxide, manganese sulfate, ferrous sulfate, sodium selenite), amino acids (lysine HCl, DL-methionine, threonine), enzymes and probiotic concentrates, antioxidants, and carrier materials such as rice bran, wheat bran, limestone powder, and dicalcium phosphate.
Beyond that core list, we’ve processed clients’ raw material specifications involving far less common ingredients — spray-dried plasma proteins as carrier matrix, clinoptilolite zeolite for mycotoxin-binding premix, phytogenic additive concentrates with very low bulk density, and selenium-enriched yeast at inclusion rates below 20g per ton. The process design adapts to what the client is actually using, not to what a standard premix line was originally built for.

Vitamin Premix

Mineral Premix

Lysine

Methionine

Choline Chloride

Salt

Carrier
Typical Premix Formulations
Broiler Compound Premix (5% inclusion rate)
Vitamin A (500,000 IU/g)
200g
Vitamin D3 (100,000 IU/g)
50g
Vitamin E (50%)
400g
Zinc oxide (72% Zn)
1,200g
Manganese sulfate (32% Mn)
800g
…
…
Piglet Starter Premix (3% inclusion rate)
Vitamin A (500,000 IU/g)
160g
Vitamin D3 (100,000 IU/g)
40g
Vitamin K3 (50%)
60g
Ferrous sulfate (30% Fe)
2,000g
Copper sulfate (25% Cu)
1,600g
…
…
Dairy Cow Premix (0.5% inclusion rate)
Vitamin A (500,000 IU/g)
300g
Vitamin E (50%)
1,000g
Niacin (bypass-protected)
2,500g
Sodium selenite (1% Se)
250g
Magnesium oxide (60% Mg)
3,000g
…
…
Layer Feed — Standard High-Calcium
Vitamin A (500,000 IU/g)
180g
Vitamin D3 (100,000 IU/g)
60g
Vitamin B12 (0.1%)
120g
Zinc sulfate (35% Zn)
900g
Iodine (potassium iodate)
30g
…
…
Shrimp Premix (3kg/ton inclusion rate)
Vitamin C (stay-C 35%)
1,800g
Vitamin E (50%)
600g
Astaxanthin (10%)
400g
Phospholipid concentrate
5,000g
Zinc amino acid chelate
800g
…
…
Sheep & Goat Mineral Premix (0.3% inclusion rate)
Sodium selenite (1% Se)
300g
Copper sulfate (25% Cu)
400g
Copper sulfate (25% Cu)
80g
Manganese sulfate (32% Mn)
1,200g
Iodized salt
8,000g
…
…
Formulation is the client’s domain — we’re equipment engineers, not nutritionists, and we don’t pretend otherwise. But after working through the raw material specifications of hundreds of premix projects, we understand ingredient behavior, handling characteristics, and processing requirements at a level that goes well beyond what’s on the spec sheet.
The reference formulas here represent commonly used starting-point formulations for each premix category. Real-world formulations vary significantly by species, production stage, regional ingredient availability, and the nutritionist’s preference. These are illustrative, not prescriptive.
Questions We Actually Get
What’s the premix feed mill price for a 1–2 t/h automatic line?
+
For a fully automatic 1–2 t/h premix feed production line with PLC batching control, stainless contact surfaces, micro-dosing unit (6–8 stations), ribbon mixer, and basic packaging, budget roughly $80,000–$180,000 USD for equipment.
That range shifts depending on automation level, number of dosing stations, mixer capacity, and whether you need liquid addition or ultra-fine milling.
We provide itemized quotes — not ranges — once we know your formulation list and building situation. Send us your specs and we’ll turn around a cost of setting up a premix feed plant specific to your project within 3 business days.
We’re an existing feed mill. Can we add a premix unit to our current facility without rebuilding?
+
Yes, and it’s one of the more common project types we handle. The key constraints are ceiling height (most premix batching layouts need 6–10 meters depending on capacity), floor load capacity for storage bins and batching towers, and available floor area for a dedicated mixing and dosing circuit.
We’ve retrofitted premix units into existing compound feed plants in Turkey, Egypt, and Colombia without major civil reconstruction — the process design works around what’s already there. Send us your floor plan and we’ll tell you what’s realistic.
Does a complete premix feed plant require a pit for the mixer discharge or batching system?
+
Not necessarily. Pit requirements depend on the process layout and available building height. If ceiling clearance allows a vertical gravity-flow arrangement, pit excavation can often be avoided.
For low-ceiling buildings (under 6 meters), a shallow receiving pit under the mixer discharge or packaging scale is sometimes the practical solution.
We design around your building — if a pit is needed, we specify the dimensions; if it can be avoided, we do that. Either way, civil drawings are included in our free design package.
How accurate does the micro-dosing system need to be for vitamin premix?
+
For vitamin premix, dosing accuracy at the micro-ingredient level should be ±0.1g or better for inclusions below 100g per batch. Standard loss-in-weight dosing units used in conventional feed batching typically run ±1–2g, which is inadequate for high-concentration vitamin concentrates.
Our micro ingredient premix systems use dedicated precision scales at each dosing station — separate from the macro batching system — calibrated specifically for the ingredient’s bulk density and flow characteristics. For selenium compounds, the accuracy tolerance is even tighter, and we specify accordingly.
What building size do I need for a 3 t/h premix feed plant?
+
A 3 t/h animal feed premix plant typically requires 350–500 m² of floor area and 8–10 meters of usable ceiling height for a standard vertical layout. That covers raw material storage, batching tower, mixing room, packaging area, and dust collection.
Tighter floor plans are possible with modified horizontal layouts, but they usually trade off either storage capacity or maintenance access. We produce a free factory area planning drawing before any contract — clients use it to finalize building dimensions or brief construction contractors.
Can one premix feed production line handle both vitamin premix and mineral premix in the same production schedule?
+
Yes, but changeover protocol matters. Vitamin premix and mineral premix use different carriers, different bulk densities, and in some formulations different mixer residence times.
Running them sequentially on the same line requires a cleanout sequence between batches — the mixer, discharge valve, and conveying circuits all need to be cleared to prevent cross-contamination.
For high-throughput operations switching between product types frequently, we often recommend a dedicated flushing cycle built into the PLC recipe management. We’ve configured this on vitamin and mineral premix production lines in Pakistan, Nigeria, and Mexico.
We want to process both premix and complete poultry feed on the same site. Does that require two separate lines?
+
Not necessarily one line, but two separate processing circuits — premix and complete feed don’t share mixing or batching equipment in a properly designed facility. What they can share is raw material intake infrastructure, some storage bins, and utility systems.
The most efficient layout we build for this scenario is a poultry feed premix plant where the premix unit feeds directly into the complete feed batching system, reducing double-handling of premix raw materials. We’ve built this configuration at 5+15 t/h combined capacity in China, Vietnam, and Afghanistan.
What’s the minimum ceiling height if I don’t want to excavate a pit?
+
For a pit-free layout on a 1–2 t/h feed premix plant, you typically need at least 7 meters clear ceiling height to allow gravity discharge from the batching hopper through the mixer to the packaging scale.
For 3–5 t/h, 8–9 meters is more comfortable. Below 6 meters, some form of pit or recessed floor section is almost always required at the mixer discharge or packaging stage.
If your building has 5.5–6 meter ceilings, we can usually design around it with a shallow 600–800mm pit rather than a full 1.5-meter excavation.
How long does it take to commission a turnkey premix feed mill from order to first production run?
+
For a standard 1–5 t/h turnkey premix feed mill, the timeline from order confirmation to first production run is typically 90–150 days: 60–90 days manufacturing, 15–25 days installation and mechanical completion, 7–14 days commissioning and trial production. Larger lines (8 t/h+) run 120–180 days.
Factors that extend the timeline: custom stainless steel fabrication, remote installation locations, and import customs clearance in certain markets. We’ve completed 3 t/h installations in Saudi Arabia and Kenya within 110 days including ocean freight.
Does your automatic premix production line support GMP+ or similar certification audits?
+
The equipment itself doesn’t carry GMP+ certification — that’s a facility-level and quality management system certification, not an equipment certificate.
What we provide is equipment designed to meet GMP+ technical requirements: full batch traceability via PLC logging, stainless steel product-contact surfaces, cleanout access on all mixing and conveying components, and no dead zones in the mixer geometry where residue accumulates.
Several clients operating our premix manufacturing facility equipment have successfully passed GMP+ audits — in the Netherlands, Germany, and Poland — using the batch records and maintenance documentation we provide at commissioning.
We’re using locally sourced rice bran as carrier. Does that create any problems for the dosing system?
+
Rice bran is one of the more common carrier materials in Southeast Asian and South Asian premix operations, and it does have a few handling characteristics worth designing around.
Moisture content variability (typically 8–13% depending on season and source) affects bulk density, which drifts the dosing accuracy on volumetric systems. We use gravimetric (weight-based) dosing rather than volumetric for this reason.
Rice bran also tends to bridge in storage bins with steep angles — anti-bridging agitators on the carrier storage are standard on our lines using this material. Clients in Bangladesh, Myanmar, and Indonesia have all raised this issue; it’s a solved problem, just one that needs to be in the design from the start.
What’s the premix feed plant cost difference between a carbon steel line and a full stainless steel line?
+
For a 2 t/h line, full 304 stainless steel throughout typically adds 40–70% to the equipment cost compared to a carbon steel structure with stainless contact surfaces.
On a $120,000 carbon-steel-structure line, that’s an additional $50,000–$80,000. Full stainless is justified for clients operating under pharmaceutical-grade or GMP+ requirements, or producing high-selenium or high-copper mineral premix where equipment corrosion is a real operational concern.
For most standard compound premix operations, the “carbon steel structure + stainless contact surface” configuration gives you the durability where it matters without the capital premium where it doesn’t.
Can a small scale premix feed plant at 0.5 t/h be fully automated?
+
Full automation at 0.5 t/h is technically possible but rarely the right investment decision. At that output scale, the cost of a full PLC batching system and automated micro-dosing unit often exceeds the cost of the mechanical equipment itself.
Most 0.5 t/h installations we build use semi-automatic batching — manual ingredient loading with automated weighing and mixer control.
That said, if the client is producing a complex formulation with 12+ micro-ingredients and running multiple shifts, automation can still justify itself on accuracy and labor savings. We discuss this trade-off openly during the design phase rather than defaulting to whatever generates the higher equipment value.
We’re planning a commercial premix feed plant to supply third-party feed mills. What capacity makes sense to start?
+
For a commercial premix feed factory targeting third-party sales, the minimum viable scale is usually 3–5 t/h — below that, the per-unit production cost and the overhead of running a commercial operation rarely pencil out against buying from an established supplier.
The clients we’ve seen succeed at the commercial scale start with 2–3 anchor customers who’ve committed to volumes before the line is specified — not after. A 3 t/h industrial premix production line running two shifts at 80% utilization produces roughly 1,400–1,500 tons per month, which is a meaningful supply position in most regional markets.
Does the feed premix batching system need to be separate from our existing complete feed batching system, or can they share infrastructure?
+
They need separate batching and mixing circuits — premix batching operates at a completely different accuracy level (gram-range micro-dosing vs. kilogram-range macro batching) and requires dedicated scale capacity that a complete feed batching system isn’t calibrated for.
What can be shared: bulk raw material intake, some storage bins for common ingredients, compressed air supply, and dust collection infrastructure. The integration point is typically at the premix output — finished premix feeds into the complete feed batching as a pre-weighed ingredient. We design the interface between the two systems as part of the combined plant layout.
We’ve seen cheap premix feed processing equipment from other suppliers at half your price. What’s the difference?
+
The price gap in premix equipment usually shows up in three places: scale calibration and long-term drift (cheap load cells lose accuracy within 6–12 months of production), mixer geometry and residue behavior (a poorly designed ribbon mixer leaves up to 3–5% of each batch as residue in the discharge zone, which affects both yield and cross-contamination), and contact surface material (carbon steel coated to look like stainless, or thin-wall stainless that corrodes within 2 years on mineral premix).
We’ve had clients come to us after a first installation with a low-cost supplier — the retrofit costs usually exceed what they saved on the original purchase. We’re not the cheapest option; we’re the option with 1,000+ installed lines that are still running.
What countries do you have premix feed plant projects in, and how do you handle overseas installation?
+
We’ve commissioned premix feed production line projects across more than 80 countries — including Ukraine, Nigeria, Peru, Iran, Pakistan, Ethiopia, and the Philippines, among many others.
Overseas installation is handled by RICHI’s own project engineers, not subcontracted to local agents. For most markets, we send 2–4 engineers for installation and commissioning; in markets with travel restrictions, we’ve completed remote-guided installations with daily video supervision. All projects include on-site trial production before handover.
Our premix formulation includes enzymes and probiotics at very low inclusion rates. Does that require special equipment?
+
Yes — enzyme and probiotic concentrates at inclusions below 50g per ton require a pre-blending step before they enter the main mixer, otherwise distribution homogeneity in the finished premix is inconsistent.
The standard approach is a small pre-blender (50–200kg capacity) where the low-inclusion functional additives are pre-mixed with a carrier fraction before being introduced into the main batch.
Temperature is also a factor: most enzyme preparations start to degrade above 40°C, so mixer friction heat on long cycles is a real concern. We configure low-shear mixing protocols and pre-blending units for functional additive premix plant clients as a standard practice, not a custom add-on.
We already have a building but the floor layout is irregular. Can you still design a feed premix plant layout around it?
+
Yes — irregular building footprints are common, and almost every project we do involves some constraint the client didn’t mention in the first inquiry. Stepped floors, off-center columns, low sections of roof, existing machinery that can’t be moved — we’ve dealt with all of it.
The free 3D rendering and layout design service exists specifically for this: we work with your actual building dimensions before anything is manufactured, so the equipment fits the space rather than the other way around.
Clients who’ve tried to reverse-engineer a standard layout into a non-standard building without this step usually end up with either wasted space or equipment that’s difficult to maintain.
Is a livestock feed premix plant suitable for also producing complete mash feed, or does that require completely separate equipment?
+
A livestock feed premix plant and a mash feed line can share a building and some infrastructure, but the processing circuits need to remain separate — particularly the mixer, batching system, and packaging.
The practical approach for clients wanting both is a combined facility design where the premix unit operates on a dedicated circuit and outputs into the mash feed batching system as a pre-weighed ingredient.
Some clients run the premix unit in the morning shift and the mash feed line in the afternoon on the same core equipment — this is possible with appropriate cleanout protocols but requires careful scheduling and formulation sequencing. We’ve built this dual-function configuration for clients in Iran, Tanzania, and the Philippines.
What does RICHI’s premix feed mill actually cover — capacity, cost, and what types of lines can you build?
+
The short answer: 1–60 t/h, $100,000–$3,000,000 USD, and we build everything from single-product vitamin premix units to fully integrated multi-species premix and complete feed combined plants. The longer answer is below.
Capacity & Investment Range
| Line Scale | Typical Capacity | Approximate Equipment Investment |
|---|---|---|
| Small farm / pilot | 1–3 T/H | $100,000 – $300,000 |
| Mid-scale commercial | 3–10 T/H | $300,000 – $800,000 |
| Industrial / integrated | 10–30 T/H | $800,000 – $1,800,000 |
| Large manufacturing | 30–60 T/H | $1,800,000 – $3,000,000 |
Note: These are equipment costs only. Civil construction, raw materials, permits, and utilities are additional.
What Types of Premix Feed Mill Can RICHI Build?
- Single premix production line — dedicated vitamin premix, mineral premix, or compound premix; one product category, optimized for accuracy and cleanout efficiency
- Poultry & livestock pellet feed + premix combined plant — premix unit integrated with a complete pellet feed line; the most common configuration for integrated poultry and swine operations
- Aqua / fish / shrimp feed + premix combined plant — premix unit feeding an extruded or pelleted aqua feed line; requires specific handling for heat-sensitive and low-inclusion aquatic additives
- Concentrate feed + premix combined plant — premix and concentrate feed produced on a shared site with independent processing circuits
New build, retrofit, or expansion — all three.
We handle new premix factory construction from greenfield, retrofits of existing feed mills adding a premix unit, and capacity expansions on lines already running. The engineering scope is the same regardless: process design, equipment manufacturing, civil layout, installation, commissioning, training.
Why Does Any of This Matter Right Now?
Global demand for formulated premix is being pushed by three converging pressures: rising protein consumption in emerging markets, tightening feed safety regulation (particularly post-ASF and avian influenza outbreaks that made biosecurity traceability mandatory in many markets), and feed producers’ growing need to reduce dependency on imported premix supply chains.
The economics of in-house premix production have improved significantly over the past decade — entry costs are lower, automation is more accessible, and the payback math has gotten easier to justify.
RICHI’s premix feed mill engineering team works from the formulation inward — understanding what the client’s raw materials and finished product specifications actually require before specifying any equipment. That’s the part that separates a line that runs correctly from one that runs, but drifts on accuracy within 6 months.
If you’re evaluating capacity options or need a project-specific cost breakdown, the fastest way forward is to share your output target, premix type, and building situation — we respond with an itemized estimate, not a range.
What technologies and systems does a complete premix feed mill construction project actually include?
+
A complete premix feed mill isn’t just a mixer and a scale. The full system spans ten distinct technology domains — and how well those domains are integrated determines whether the line runs at specification or spends its first year being adjusted. Here’s what a complete build covers:
Core Technology Systems in a Complete Premix Feed Mill
| # | System | What It Does in a Premix Context |
|---|---|---|
| 1 | Raw Material Intake & Adoption Technology | Receiving hoppers, bag dump stations, bulk truck intake — configured for both high-density mineral ingredients and low-density vitamin carriers |
| 2 | Silo & Storage Systems | Flat-bottom bins and day silos for bulk carriers; sealed storage for hygroscopic vitamin materials; segregated mineral storage |
| 3 | Bulk Material Conveying | Screw conveyors, bucket elevators, pneumatic circuits — contact surfaces in 304 stainless for product-contact sections |
| 4 | Dosing & Weighing Systems | Macro batching scales for carriers and bulk minerals; precision micro-dosing units (±0.1g accuracy) for vitamin and trace element inclusions |
| 5 | Grinding & Screening Technology | Hammer mills and ultra-fine grinders for particle size reduction to <150 microns; screening to ensure uniformity before blending |
| 6 | Mixing Systems | Ribbon mixers, paddle mixers, or twin-shaft paddle mixers depending on batch size and blend homogeneity requirements |
| 7 | Hygienization & Sanitation Systems | Cleanout access on all product-contact equipment; flushing sequences for cross-contamination control between formulation changes |
| 8 | Dust Collection & Filtration | Pulse-jet bag filters and cyclone separators; critical for fine mineral powders and vitamin dusts with strict occupational exposure limits |
| 9 | Packaging Technology | Open-mouth bag fillers, valve bag systems, bulk bag (500–1,000kg) stations; weight-check scales integrated into the packaging line |
| 10 | PLC Control & Process Management | Recipe-based batching control, batch logging, SCADA interfaces, ERP integration options for full production traceability |
What “Complete Construction” Actually Means
Some suppliers sell equipment and call it a complete project. What we mean by complete premix feed mill construction is different:
- Analysis & Feasibility — raw material assessment, formulation review, production target validation
- Concept Development — process flow design, equipment selection, automation level recommendation
- Project Planning — civil layout, structural drawings, utility specifications, timeline
- Equipment Manufacturing — all systems produced in-house at our 330,000 m² facility
- Delivery & Logistics — export packaging, shipping coordination, customs documentation
- Installation & Site Management — RICHI engineers on-site, not subcontracted
- Commissioning & Trial Production — full production runs on client’s actual raw materials before handover
On Premix Concentration Ranges
The original text mentions 0.2% premixes and 10–20% supplementary feeds — both are within our scope, and they’re meaningfully different production challenges.
A 0.2% inclusion premix (used at 2kg per ton of complete feed) requires extremely high micro-ingredient accuracy and excellent blend homogeneity to deliver consistent nutrition.
A 10–20% supplementary feed runs at much higher inclusion rates with different carrier ratios and packaging requirements. The equipment configuration, dosing station count, and mixer volume are specified differently for each. Neither is a challenge — they just require different starting points in the design process.
What does the process flow of a premix feed mill actually look like — and how does the batching automation level affect the design?
+
Premix production is technically demanding in ways that aren’t obvious until you’re specifying the line.
The formula design is only part of it. Raw material handling, metering accuracy, mixing sequence, packaging integrity, and dust control all affect finished product quality — and in premix, quality failures don’t show up at the mill, they show up in the animals fed downstream.
That’s a longer feedback loop than most equipment problems, which means getting the process design right from the start matters more than in most feed production categories.
Standard Process Flow in a Premix Feed Mill
| Stage | Key Equipment | Critical Control Points |
|---|---|---|
| 1. Raw Material Receiving | Receiving hoppers, weighing systems, unloading conveyors, dust control, inspection instruments | Incoming weight verification; moisture and contamination checks before storage |
| 2. Cleaning & Screening | Rotary screens, magnetic separators | Removal of foreign material and oversized particles before grinding or batching |
| 3. Grinding | Hammer mills, ultra-fine grinders | Particle size reduction to specification — typically <500 microns for compound premix, <150 microns for specialty vitamin premix |
| 4. Batching | Macro scales, micro-dosing units, recipe management PLC | Accuracy at both macro level (kg-range carriers) and micro level (gram-range vitamins and trace elements) |
| 5. Mixing | Ribbon mixer, paddle mixer, or twin-shaft mixer | Homogeneity across all ingredient ratios; micro-mixing of <1% inclusions before macro mixing |
| 6. Packaging | Bag filling machines, weight checkers, label applicators, palletizers | Bag weight accuracy; seal integrity for moisture-sensitive premix products |
| 7. Dust Collection | Pulse-jet bag filters, cyclone separators, ventilation ducting | Continuous dust extraction at all transfer and mixing points; occupational safety compliance |
The Two-Step Mixing Logic — Why It Matters
One detail worth understanding: proper premix mixing isn’t a single operation. It’s two.
- Micro-mixing handles ingredients that represent less than 1% of the total batch weight — vitamin concentrates, selenium compounds, enzyme preparations. These go into a small pre-blender first, combined with a fraction of the carrier, before entering the main mixer. This step is frequently omitted on poorly designed lines, and it’s one of the main reasons homogeneity fails in finished premix.
- Macro-mixing combines all pre-blended micro-ingredients with the remaining carrier and bulk mineral ingredients in the batch mixer.
Skipping the pre-blending step for low-inclusion ingredients and adding them directly to the main mixer is a common specification error — the main mixer doesn’t have the residence time or geometry to distribute gram-level inclusions evenly across a 500–2,000kg batch.
Three Levels of Batching Automation
The premix feed manufacturing process can be configured at three automation levels, each with different capital requirements and labor implications:
- Manual batching — operators weigh and add each ingredient by hand; lowest capital cost, highest labor requirement, accuracy depends entirely on operator consistency. Suitable for very small operations (<0.5 t/h) or pilot-scale facilities.
- Semi-automatic batching — carriers and fixed-ratio bulk ingredients are handled automatically; minor ingredients are still manually weighed and added. A practical middle ground for 1–3 t/h lines where full automation cost isn’t yet justified by output volume.
- Fully automatic batching — all ingredients, including micro-dosing at gram-level precision, are handled by the PLC-controlled system. Batch records are logged automatically. This is standard on commercial premix operations above 3 t/h, and required for any facility targeting GMP+ or equivalent certification.
On Raw Material Preprocessing
Most dedicated premix factories purchase vitamins, trace minerals, amino acids, and carriers from specialized raw material suppliers and don’t need preprocessing equipment on-site.
That’s the standard setup. However, some clients — particularly those in markets with unreliable supply chains or those producing specialty premix from locally sourced materials — do require on-site grinding, drying, or screening of raw materials before they enter the batching stage.
We design for both scenarios. The preprocessing modules (grinding, screening, drying) are specified only if the client’s raw material supply actually requires them — adding equipment that isn’t needed increases capital cost and maintenance load without adding production value.
Beyond the equipment price, what does a premix feed mill actually cost to operate — and what should I budget for total investment?
+
The equipment price is the number most buyers ask about first, and it’s the easiest part of the budget to nail down. A complete premix feed mill equipment package (1–60 t/h, including silos) runs $100,000–$3,000,000 USD depending on capacity, automation level, and material specifications. That figure covers everything we manufacture and supply.
What it doesn’t cover is the total cost of running a premix operation — and that’s the number that actually determines whether the investment makes sense.
Two Categories of Cost to Budget
① One-Time Capital Investment
| Cost Item | What’s Included |
|---|---|
| Equipment package | Complete premix feed production line, silos, control system, packaging — everything RICHI supplies |
| Civil construction | Building, foundations, pit work, utilities connections |
| Installation & commissioning | On-site engineering labor (included in RICHI’s project scope for overseas clients) |
| Raw material initial stock | First production run inventory — vitamins, minerals, carriers |
| Permits & compliance | Feed manufacturing license, environmental approvals, GMP certification where required |
② Ongoing Operational Cost per Ton Produced
This is where most investment analyses stop too early. The real cost-per-ton calculation needs to include:
- Equipment depreciation — core mechanical equipment on a premix line typically carries a 10–15 year useful life; divide capital cost across expected production volume
- Labor — operator headcount varies from 2 persons (semi-auto 1–2 t/h) to 6–8 persons (fully automatic 10+ t/h with packaging)
- Energy consumption — a 3 t/h premix line typically draws 30–60 kW installed load depending on grinding and conveying configuration; electricity cost per ton varies significantly by country
- Maintenance & spare parts — budget 1.5–3% of equipment value annually for planned maintenance; higher in dusty or high-humidity environments
- Raw material cost — the dominant variable in premix economics; vitamin and trace mineral prices fluctuate and need to be modeled against local commercial premix purchase price to validate payback
The Payback Calculation That Actually Matters
For clients currently purchasing commercial premix, the investment decision comes down to one comparison: cost to produce in-house vs. cost to buy. In most markets we’ve worked in — Southeast Asia, Africa, Latin America, the Middle East — clients purchasing more than 50–80 tons of premix per month find that in-house production breaks even within 2–4 years at 3 t/h scale. Below that purchase volume, the economics are tighter and depend heavily on local premix pricing.
We handle 0.2% inclusion premix lines and 10–20% supplementary feed plants — both are within standard project scope, and the cost structure differs between them. Neither is a calculation you need to work through alone.
Our project consultants will walk through the full investment model with you — equipment quote, operating cost estimate, and payback projection based on your actual production volume and local market pricing. No obligation to proceed; the analysis is part of what we provide before any contract is signed.
Can you show real premix feed mill projects with actual costs — and do you supply individual modules or only complete lines?
+
Both. We supply complete turnkey premix feed mill projects, individual equipment modules, and capacity extensions for existing lines. Everything is assembled and factory-tested at our facility before shipment — not flat-packed and figured out on-site.
That pre-delivery testing is what keeps commissioning timelines predictable and avoids the kind of on-site problem-solving that runs up installation costs.
Documented Project References — Actual Costs & Timelines
| Project | Capacity | Completion | Equipment Investment |
|---|---|---|---|
| Animal Premix Feed Mill, El Salvador | 5 T/H | Sep 2022 | $480,000 USD |
| Poultry Premix Feed Mill, Thailand | 10 T/H | Jul 2021 | $120,000 USD |
| Premix Feed Mill, Uzbekistan | 5 T/H | Apr 2020 | $240,000 USD |
| Premix Feed Manufacturing Plant, China | 20 T/H | Mar 2018 | $1,260,000 USD |
| Premix Feed Mill Factory, China | 10 T/H | Aug 2015 | $740,000 USD |
| Premix Feed Mill Plant, China | 15 T/H | Apr 2017 | $980,000 USD |
Note on the Thailand project: the $120,000 figure reflects a specialized 10 t/h poultry premix configuration — smaller equipment scope than a full compound premix line at equivalent capacity, which is why the cost sits lower than comparable tonnage projects.
Export Markets — Where These Lines Are Running
Beyond the projects listed above, our premix feed mill equipment has been commissioned in:
- Americas: United States, Argentina, El Salvador, Brazil, Colombia
- Middle East & Central Asia: Saudi Arabia, Uzbekistan, Kazakhstan, Iran
- Africa: South Africa, Zimbabwe, Ethiopia, Nigeria, Kenya
- Asia-Pacific: Indonesia, India, Thailand, Vietnam, Philippines
- Europe: Russia, Poland, Germany, Ukraine
The range of markets matters because it reflects real variation in installation conditions — cold-climate facilities in Kazakhstan, high-humidity coastal plants in Indonesia, facilities with unstable power supply in parts of Africa. Lines that work across that range aren’t built to a single template.
Complete Plant vs. Modules vs. Individual Equipment
Not every client needs a full greenfield build. We supply at three levels:
| Supply Scope | Typical Client Situation |
|---|---|
| Complete turnkey premix feed plant | New facility, no existing premix equipment; client wants single-source responsibility from design to commissioning |
| Extensions & capacity modules | Existing premix line running at capacity ceiling; client needs additional mixer, dosing stations, or packaging circuit without rebuilding the full system |
| Individual feed premix processing equipment | Specific piece of equipment has failed or reached end of life; client needs a replacement that matches existing line specifications |
All three supply modes use the same manufacturing standards and carry the same warranty terms. The modular assembly and pre-testing approach means that whether we’re shipping a complete plant or a single micro-dosing unit, it arrives configured and verified — not requiring on-site calibration from scratch.
If you’re looking at a specific capacity range or have an existing line that needs extending, share the details and we’ll confirm what scope makes sense.
Which specific pieces of equipment make up a premix feed mill, and what are the key specs to evaluate when selecting them?
+
Equipment selection for a premix line isn’t just about capacity — it’s about accuracy, cleanability, and material compatibility at each stage. The wrong mixer geometry or an undersized batching scale creates problems that don’t announce themselves immediately; they show up gradually as batch-to-batch variation in the finished premix. Here’s a breakdown of the core equipment, what to look for, and why each piece matters in a premix context specifically.
Stainless Steel — Where It’s Non-Negotiable
Before getting into individual equipment: in a premix feed mill, every piece of equipment and hopper that makes direct contact with the product must be stainless steel — 304 as a minimum, 316L for high-selenium or high-copper mineral premix applications. This applies from the mixer through to the packing scale. Structural frames, elevator casings, and external housings can be carbon steel. The contact surface rule is firm, and it’s the first thing to verify when evaluating any premix equipment supplier.
Core Equipment Specifications
① Hammer Mill Grinder
Most premix operations that process their own carrier material need a grinding stage. Limestone powder and rice bran often arrive at particle sizes that don’t meet premix blending specifications without pre-grinding. The carrier goes through the hammer mill, then moves by elevator into the batching system.
| Spec | Range |
|---|---|
| Capacity | 3–25 T/H |
| Main Motor Power | 30–160 KW |
| Key Selection Factor | Screen size determines output particle size; 1.0–2.0mm screens are typical for premix carriers |
Note: Not all premix lines require a grinding stage. If the client purchases pre-ground carrier material, this equipment can be omitted — which is the case for most dedicated vitamin premix operations.
② Batching & Weighing System
Batching accuracy is the single most critical performance parameter in premix production. The challenge is that ingredient ratios vary enormously — a carrier at 80kg per batch and a vitamin concentrate at 5g per batch cannot be accurately weighed on the same scale. The correct approach is a multi-scale configuration:
- Large scale — bulk carriers and macro minerals (kg range)
- Medium scale — mid-range ingredient additions (100g–5kg range)
- Small / micro scale — vitamin concentrates, trace elements, functional additives (gram range, ±0.1g accuracy)
| Spec | Range |
|---|---|
| Capacity | 1–2,000 KG/H |
| Control System | PLC-based recipe management |
| Batching Methods | Fully automatic / semi-automatic / manual — configured by output scale and formulation complexity |
③ Premix Mixer
The mixer is where the line either performs or doesn’t. For premix applications, two mixer types are standard:
- Twin-shaft paddle mixer — high mixing intensity, short cycle time (typically 2–4 minutes to homogeneity), full-length bottom discharge door with zero residue design; better suited for complex compound premix with wide ingredient ratio variation
- Single-shaft double-blade mixer — gentler mixing action, longer residence time; used where shear-sensitive ingredients (certain enzyme preparations, probiotic concentrates) need protection from mechanical degradation
Both types achieve a coefficient of variation (CV) below 5% — the industry standard for premix homogeneity. Our mixers reach CV of 2–3% under normal operating conditions.
| Spec | Range |
|---|---|
| Batch Capacity | 250–2,000 KG |
| Motor Power | 4–55 KW |
| Key Design Features | Full-length discharge door (zero residue); pneumatic cleanout; shaft-end seal (no product leakage); stainless steel interior |
④ Packaging / Packing Scale
Premix is typically bagged at 5–30 kg per bag for commercial distribution. Two configurations are used depending on product flow characteristics:
- Stainless steel oblique auger with bucket scale — for free-flowing premix products
- Stainless steel loss-in-weight (gross weigh) packing scale — for premix with variable bulk density or bridging tendency
| Spec | Range |
|---|---|
| Output Speed | 6–12 bags/minute |
| Motor Power | 1.1–5 KW |
| Bag Weight Range | 5–50 KG |
⑤ Pulse Jet Dust Collector
Dust control in a premix facility isn’t optional — fine mineral powders and vitamin dusts present real occupational health risks, and certain compounds (selenium, copper) have strict workplace exposure limits. A properly designed dust collection system also recovers valuable product that would otherwise be lost as airborne particulate.
| Spec | Range |
|---|---|
| Motor Power | 0.75–15 KW |
| Model Series | TBLM |
| Application Points | All material transfer points, mixer inlet/outlet, packaging station, grinding discharge |
How Equipment Selection Is Actually Done
Each premix feed mill we build is specified around the client’s raw materials and formulation list — not from a standard catalog. The same 5 t/h capacity line looks different depending on whether it’s producing vitamin premix on rice bran carrier, mineral premix with copper sulfate and selenium, or compound premix across multiple species. Ingredient flow characteristics, corrosivity, particle size requirements, and cleanout frequency all affect which equipment configuration is correct.
The production control system logs all key parameters — batch weights, mixing times, dosing quantities, operator records — generating reports that support both quality management and regulatory compliance. Conveying and dosing system geometry is designed specifically to minimize ingredient segregation during transfer, which is a common failure point on lines that weren’t engineered for premix from the outset.
If you have a formulation list or raw material specification, send it through — equipment selection gets a lot more precise once we know what’s actually going into the mixer.
What makes RICHI’s premix feed mill process design technically different from a standard feed production line?
+
Premix production has fundamentally different engineering priorities than compound feed manufacturing — and a line designed without understanding those priorities will run, but won’t perform. The six characteristics below define how our premix feed mill process is engineered, and why each one matters in actual production.
① Short Process Route — Less Transfer, Less Contamination Risk
The premix production flow is deliberately kept short. After batching and mixing are complete, finished premix moves directly to packaging — no intermediate conveying stages, no storage buffers between mixing and bagging.
Every additional transfer point is a potential segregation point and a cross-contamination risk. In a vitamin premix context, where active ingredient concentrations are measured in grams per ton, even minor cross-contamination between batches affects product integrity.
Raw materials are routed on dedicated lines to prevent contact between incompatible ingredients before they reach the mixer.
② Multi-Tier Batching Accuracy — The Numbers Behind It
This is where most premix lines either earn their specification or fail it. Because premix ingredient ratios span several orders of magnitude — from 500kg of carrier to 5g of a vitamin concentrate in the same batch — a single batching scale cannot handle the full range accurately.
RICHI Machinery configures 3–4 independent batching points per line, each calibrated for a specific weight range:
| Ingredient Category | Weighing Accuracy | Scale Type |
|---|---|---|
| Carrier (bulk) | ±0.25% | Large macro scale |
| Constant components | ±0.1% | Medium scale |
| Medium components | ±0.03–0.05% | Medium-small scale |
| Trace components (vitamins, selenium, etc.) | ±0.01–0.02% | Precision micro scale |
Large quantities use large scales; gram-level micro-ingredients use dedicated precision scales. This is not negotiable in a properly specified premix line — a single universal scale cannot meet the accuracy requirements across this range.
③ Mixing Uniformity — CV ≤5%, Residue <100g/t
The coefficient of variation (CV) for mixing uniformity on RICHI stainless steel mixers is ≤5% under standard operating conditions — and typically reaches 2–3% in practice. That’s the metric that determines whether the nutritional specification in the formula actually ends up distributed evenly in the finished bag.
Two design details that directly affect this:
- Full-length large-opening discharge door — eliminates dead zones at the mixer base where residue accumulates between batches
- Residue target <100g per ton — minimizes cross-batch contamination from trace components left in the mixer after discharge
On lines producing multiple premix formulations in sequence, this residue spec matters more than most buyers initially realize.
④ Active Ingredient Protection — Compatibility by Design
Feed additives don’t all coexist peacefully. Certain vitamins oxidize in the presence of trace minerals; choline chloride is corrosive to fat-soluble vitamins; some enzyme preparations are inactivated by prolonged contact with mineral concentrates at elevated temperature. The process design accounts for ingredient compatibility — sequencing additions to the mixer to minimize contact time between reactive components, keeping mixing temperatures controlled, and isolating incompatible ingredients during the batching stage.
This isn’t something that can be retrofitted after a line is built. It has to be designed in from the process flow stage, which is why our engineering team works through the client’s formulation list before any equipment is specified.
⑤ Corrosion Resistance — Material Specification by Function
Most premix raw materials — vitamin concentrates, copper sulfate, sodium selenite, ferrous sulfate — are corrosive to uncoated carbon steel surfaces over time. The material specification rule we apply:
- All product-contact surfaces: 304 stainless steel minimum; 316L for high-copper and high-selenium applications
- Structural frames, external housings, elevator casings: carbon steel acceptable
- Shaft seals on mixers and conveyors: engineered specifically for premix duty to prevent product leakage and ingress
Equipment that looks like stainless but uses thin-wall carbon steel with a surface coating will show corrosion failure within 18–24 months on mineral premix duty. We specify by material grade, not by appearance.
⑥ Dust Control — Sealed System, Point-by-Point Extraction
Fine particle size is inherent to premix production — and dust generation is a constant across every stage. The control approach isn’t a single dust collector on the roof; it’s a sealed system with dedicated extraction at every generation point:
Dust extraction points in a complete premix feed mill:
- Trace component dosing stations
- Raw material feeding points
- Mixer inlet and discharge
- Packaging station (bagging and sealing)
- Manual operation areas
- Finished product warehouse transfer
Each connection between equipment is sealed. Suction hoods and extraction ports are positioned at each of the above points, feeding into a pulse-jet bag filter system sized for the total dust load. Dust recovered by the collection system is reintroduced into production where formulation permits — reducing waste and keeping the facility environment within occupational exposure limits for hazardous mineral dusts.
The Underlying Design Philosophy
What these six characteristics add up to is a premix feed mill that’s engineered around what premix production actually demands — not adapted from a compound feed template.
The process is short by design, accurate by specification, and protective of the ingredients that make premix worth producing in the first place. Investment cost is calibrated to production scale; there’s no single configuration that applies universally, which is why the process design phase comes before any equipment selection.
I already run a poultry feed mill — what actually needs to change to retrofit it into a premix feed mill?
+
This is one of the most common project types we handle, and the honest answer is: more than most poultry feed operators expect, but less than building from scratch. The equipment list for a premix line is shorter than a complete feed line — no pellet mill, no cooler, no crumbler.
But the precision requirements on the equipment that remains are significantly higher. A mixer that performs adequately for compound feed batching will not meet premix specification. Same goes for the batching system.
Premix is the upstream foundation of the entire feed supply chain — even at 0.2–5% inclusion in the finished feed, it determines the nutritional outcome for the animal. Getting the retrofit right matters.
The Four Engineering Problems a Poultry-to-Premix Retrofit Must Solve
① Mixer Performance — Uniformity and Zero Residue
A standard poultry feed mixer is designed for homogeneity at relatively forgiving tolerance levels. Premix requires CV ≤5% (and ideally 2–3%), with no dead zones in the mixing chamber and no residue remaining in the discharge after each batch.
What this means in practice:
- Existing ribbon mixers or single-shaft mixers designed for compound feed typically leave 300–800g/t of residue in the discharge zone
- Premix specification requires residue <100g/t
- The discharge door geometry, shaft seal design, and interior surface finish all need to meet premix-grade standards
Retrofit path: In most cases, the existing mixer needs to be replaced with a stainless steel twin-shaft paddle mixer or single-shaft double-blade mixer designed specifically for premix duty. Retrofitting a compound feed mixer is rarely cost-effective compared to replacement.
② Batching Accuracy — Multi-Scale Configuration
The batching system in a poultry feed mill is calibrated for ingredients measured in kilograms — soybean meal, corn, limestone at 50–500kg per batch. Premix batching includes ingredients at 5–50g per batch. These cannot be accurately weighed on the same scale.
| What Your Current Line Has | What a Premix Line Needs |
|---|---|
| 1–2 batching scales, kg-range accuracy | 3–4 independent batching points |
| ±0.5–1% weighing tolerance | ±0.01–0.02% for trace components |
| Single PLC recipe for macro ingredients | Multi-tier recipe management across weight ranges |
The retrofit requires adding dedicated micro-dosing stations alongside any existing macro batching infrastructure that can be retained.
③ Cross-Contamination Control — Low Residue Throughout the System
In a poultry feed line, residue in conveyors and elevators between batches is a minor quality issue. In a premix line, it’s a product safety issue — trace mineral or vitamin residue from one batch appearing in the next at uncontrolled concentrations directly affects the nutritional specification of the finished premix.
Every conveying and elevating component in the retrofitted line needs to meet low-residue design standards:
- Screw conveyor flights sized and pitched to minimize heel material
- Bucket elevator boot sections designed for cleanout access
- All product-contact surfaces in stainless steel
- Automated or semi-automated flushing sequences between formulation changes
This is the part of a poultry-to-premix retrofit that gets underestimated most often. The conveying system between a batching tower and a mixer looks simple — but if it’s carrying residue from a mineral premix batch into a vitamin premix batch, the problem shows up in animal performance data weeks later, not on the production floor immediately.
④ Dust Control — Operator Safety and Product Integrity
Premix raw materials are considerably finer than typical poultry feed ingredients, and several of them — selenium compounds, copper sulfate, vitamin dusts — have strict occupational exposure limits. The dust control system in a poultry feed retrofit for premix duty needs to be redesigned, not just extended.
Minimum extraction points required:
- Each micro-dosing and trace component addition station
- Mixer inlet and discharge
- All manual addition points
- Packaging and bagging station
- Any manual handling areas
The existing dust collection system in most poultry feed mills is sized and positioned for coarser grain dust — it won’t handle fine mineral particulate at the same extraction efficiency. A dedicated pulse-jet bag filter system, properly sized for the premix line’s dust load, is standard.
What We Do in a Retrofit Project
When we take on a poultry feed mill to premix feed mill conversion, the process starts with a site assessment — what exists, what can be retained, what needs to be replaced, and what the building layout allows. We’ve completed this type of retrofit in facilities across Southeast Asia, the Middle East, and Africa, working within existing building footprints without major civil reconstruction in most cases.
The deliverable is a retrofitted premix feed mill that meets production accuracy and cross-contamination control standards from day one — not a poultry feed line running premix formulations and hoping the results are good enough.
If you have floor plans or existing equipment lists, send them through and we’ll give you a specific assessment of what the retrofit involves and what it costs.
Which raw materials actually need to be ground in a premix feed mill, and what particle size standards apply?
+
Not everything in a premix formulation requires grinding — but the materials that do need it have specific particle size targets that directly affect blend homogeneity and biological efficacy in the finished product. Getting particle size wrong at the grinding stage is one of those problems that can’t be corrected downstream.
The reason grinding matters in premix specifically: uniform distribution of trace components through the carrier depends on the particle size compatibility between ingredients.
If the carrier is significantly coarser than the trace mineral or vitamin being blended into it, segregation occurs during mixing and handling — and the finished premix doesn’t deliver consistent nutrition batch to batch.
Materials That Require Grinding in a Premix Feed Mill
| Material Category | Typical Examples | Grinding Requirement |
|---|---|---|
| Grain-based carriers | Corn, wheat bran, rice bran | Yes — must meet premix particle size spec before entering mixer |
| Mineral carriers | Calcium bicarbonate (limestone powder), dicalcium phosphate | Yes — particle size affects carrier-to-additive blending uniformity |
| Mineral salts | Copper carbonate, ferrous sulfate, zinc oxide, manganese sulfate | Often yes — commercial grades vary in particle size; grinding ensures consistency |
| Trace mineral compounds | Cobalt carbonate, calcium iodate, sodium selenite | Yes for most — fine grinding required to meet trace element premix spec |
| Pre-purchased fine materials | Vitamin concentrates (most commercial grades) | Usually no — purchased at specification particle size; verify before assuming |
Practical note: Most dedicated vitamin premix operations purchase carrier materials that are already ground to specification from their supplier, which means the on-site grinding stage can be omitted. Whether grinding is needed depends on the client’s raw material supply — it’s one of the first questions we ask during process design.
Particle Size Standards by Premix Type
These are the standard specifications that grinding output needs to meet — and that the grinding system needs to be sized and screened to achieve consistently:
| Premix Type | Sieve Requirement | Retention Limit |
|---|---|---|
| Compound premix (vitamin + mineral + amino acid) | 100% pass 16 mesh (1.18mm) | ≤10% retained above 30 mesh (0.6mm) |
| Trace element premix (mineral-focused) | 100% pass 40 mesh (0.425mm) | ≤20% retained above 80 mesh (0.18mm) |
| Specialty / ultra-fine premix (e.g. aquatic, pharmaceutical-grade) | 100% pass 100 mesh (0.15mm) | Application-specific — confirm with nutritionist |
The trace element premix specification is considerably finer than compound premix — which means the grinding system needs to be selected for the most demanding particle size target in the client’s product range, not for the average.
Why Particle Size Affects Biological Efficacy — Not Just Blending
This point gets overlooked in equipment discussions. Finer particle size in trace mineral compounds increases surface area available for absorption in the animal’s digestive tract. Selenium and iodine compounds in particular show measurable differences in bioavailability between coarsely ground and finely ground forms. The grinding stage in a premix feed mill isn’t just a processing step — it’s part of the product quality specification.
For clients producing premix for high-performance species (broiler breeders, aquaculture species, dairy cattle), particle size at the grinding stage is worth verifying against nutritionist recommendations, not just against the standard sieve spec.
Grinding Equipment We Configure for Premix Applications
| Equipment Type | Suitable For | Output Particle Size |
|---|---|---|
| Hammer mill | Grain carriers (corn, bran), bulk mineral salts | Down to 0.5–1.0mm (16–30 mesh range) |
| Ultra-fine grinder / micro pulverizer | Trace mineral compounds, specialty carriers | Down to 0.15mm (100 mesh) and below |
| Air classifier mill | Heat-sensitive vitamin carriers, enzyme carriers | Fine and ultra-fine with temperature control |
Screen selection on the hammer mill determines output particle size — we specify the screen configuration based on the client’s target premix type, not a default setting.
For clients producing both compound premix and trace element premix on the same line, a two-stage grinding approach (coarse grind for carrier, fine grind for mineral compounds) is sometimes the right configuration.
Does a premix feed mill need a raw material drying stage — and which materials are most likely to require it?
+
Drying isn’t a standard stage on most premix lines — but it’s not optional for operations where raw material moisture is a real variable. Whether you need it depends on what you’re processing, where your raw materials are sourced, and how they’re stored before they reach the batching stage.
The moisture threshold that matters: premix raw materials generally need to be below 10% moisture content before entering the batching and mixing stages.
Above that threshold, several problems compound each other — hygroscopic ingredients clump and don’t flow through dosing equipment correctly, vitamin stability degrades faster in the presence of moisture, and finished premix shelf life drops measurably.
Moisture in the carrier is the most common source of the problem; it’s rarely the vitamin concentrates or mineral salts themselves that arrive wet, but rice bran and wheat bran in particular absorb atmospheric moisture quickly in humid climates.
Which Raw Materials Are Most Likely to Need Drying
| Material | Moisture Risk | Typical Problem If Not Dried |
|---|---|---|
| Rice bran | High — absorbs moisture rapidly, especially in tropical climates | Clumping in storage bins, bridging in dosing hoppers, reduced shelf life |
| Wheat bran | Medium-high — seasonal variation in moisture content | Batching weight drift due to bulk density change with moisture |
| Corn (grain carrier) | Medium — depends on harvest season and storage conditions | Mold risk at >12%; affects carrier quality before grinding |
| Limestone powder | Low for most sources | Usually arrives dry; coastal or humid storage can cause caking |
| Mineral salts (ferrous sulfate, copper sulfate) | Medium — some grades are hydrated forms that absorb additional moisture | Caking and flow problems in micro-dosing equipment |
| Vitamin premix concentrates | Low — commercial grades are typically stabilized | Heat damage from drying is a risk; these should not be dried directly |
Critical caution: Fat-soluble vitamins (A, D, E, K) are heat-sensitive. Raw materials containing active vitamin concentrates should never go through a direct drying process — heat exposure degrades potency. Drying applies to carriers and mineral raw materials only, not to vitamin-active ingredients.
Drying Equipment Options — Matched to Volume
The original text outlines two practical approaches, both of which we incorporate into facility design where drying is required:
For small drying volumes:
- Electric oven or cabinet dryer — batch operation, manual loading
- Suitable for operations drying <500kg per shift
- Low capital cost, easy to operate, no special installation required
For larger drying volumes:
- Dedicated drying room configuration:
- Raw material trolleys with drying trays (for even air circulation)
- Exhaust fan system for moisture removal
- Electric or steam heating coils
- Automatic temperature control instruments to prevent overheating
| Drying Method | Suitable Volume | Temperature Control | Capital Cost |
|---|---|---|---|
| Electric cabinet oven | <500 kg/shift | Basic thermostat | Low |
| Drying room (electric heating) | 500–3,000 kg/shift | Automatic PID control | Medium |
| Drying room (steam heating) | 1,000–5,000 kg/shift | Automatic PID control | Medium-high |
How We Address This in Premix Feed Mill Design
Whether drying is included in a project scope depends on the client’s raw material situation — not on a standard template. During the process design phase, we review:
- The moisture content of the client’s primary carrier materials (tested or supplier-documented)
- Local climate conditions and storage infrastructure
- Whether sealed, climate-controlled storage can substitute for active drying in some cases
- The production volume requiring drying vs. the cost of the drying installation
For clients in high-humidity markets — coastal Southeast Asia, West Africa, parts of South America — sealed storage with dehumidification is sometimes a more practical solution than adding a drying stage, particularly for operations running below 3 t/h where a full drying room installation may not be cost-justified. We’ve configured both approaches across different projects and advise based on what the raw material supply actually looks like, not on a default equipment list.
How should ventilation and dust collection be designed in an animal premix feed plant — and what makes it different from a standard feed mill?
+
Yes, dust control in a premix feed plant is not optional — and the design requirements are more demanding than in a compound feed facility. The reason is straightforward: premix raw materials are almost entirely fine powders, particle sizes are smaller than most feed ingredients, and several of the compounds involved (selenium, copper, certain vitamin dusts) have occupational exposure limits that require active management, not just general ventilation.
The standard approach in a compound feed mill — a central dust collector with branch ducting — doesn’t translate directly to premix duty. The particle size, the hygroscopicity of the materials, and the cross-contamination sensitivity between formulations all require a more considered system design.
Primary Dust Generation Points in a Premix Feed Mill
These are the locations where dust extraction is non-negotiable:
| Dust Generation Point | Risk Level | Notes |
|---|---|---|
| Raw material feeding / bag dump stations | High | Fine powder release at every bag opening |
| Manual batching tables | High | Operator exposure to trace mineral and vitamin dusts |
| Mixer inlet (manual addition port) | High | Direct exposure risk; cross-contamination between batches |
| Packaging / bagging station | High | Dust release during bag filling and sealing |
| Equipment connection points and transfer chutes | Medium | Gaps and joints between conveyors, elevators, hoppers |
| Silo vents and bin tops | Medium | Displacement air during filling carries fine dust |
Design Principles — How the System Should Be Configured
The core design principle for premix dust control follows a specific sequence:
“Seal first, extract second”
Sealing equipment connections and enclosing transfer points eliminates dust at the source. Extraction handles what sealing can’t contain. A system that relies entirely on suction without sealing will always underperform — the extraction volume required becomes impractical, and energy consumption increases significantly.
Beyond that principle, three specific technical requirements apply to premix dust systems that don’t apply to standard feed mills:
① Controlled suction velocity at dust collection points
This is the detail most dust system designers miss on premix applications. Because premix raw materials include active ingredients — vitamin concentrates, trace minerals — excessive suction velocity at the extraction port pulls product out of the process stream, not just dust. The result is active ingredient loss and formula deviation.
- Suction velocity at the extraction port should be calibrated to capture dust without entraining product
- For fine vitamin dusts: lower velocity settings than for mineral dusts
- Adjustable dampers at individual extraction points allow calibration per location
② Single-point dust removal at the mixer manual feed port
For manual addition points at the mixer — where small-volume micro-ingredients are added by hand — centralized ducting creates cross-contamination risk. Dust captured at a selenium dosing point and returned through a central system to a vitamin premix batch is a contamination event. Single-point dust collectors at each manual addition station eliminate this risk by keeping captured material isolated per station.
③ Bag filter as mandatory final stage
Whether the system uses single-stage or two-stage dust removal upstream, a bag filter is required as the final collection stage. Cyclone separators alone are insufficient for the particle sizes involved in premix dust — fine vitamin and mineral particles pass through a cyclone and are released to atmosphere or returned to the facility air. Bag filters capture these particles.
Dust Collector Maintenance — The Hygroscopicity Problem
This is a maintenance issue specific to premix facilities that standard feed mill dust system guidance doesn’t cover adequately.
Premix raw materials and finished products are strongly hygroscopic — they absorb moisture from the air. Dust captured in the bag filter carries this hygroscopicity. In humid environments, or during seasonal humidity changes, the filter bags become damp, which causes:
- Reduced filtration efficiency as wet dust blinds the bag surface
- Accelerated bag degradation and premature failure
- Risk of mold growth in accumulated dust deposits
Maintenance requirements for premix dust collector bags:
- Increase pulse-cleaning frequency during high-humidity periods
- Inspect bags monthly; dry regularly (remove and air-dry if facility humidity is consistently high)
- Replace damaged bags immediately — a torn bag bypasses the filtration stage entirely
- In tropical or coastal installations, consider hydrophobic-coated filter bags as a longer-term solution
How We Design Dust Systems in Premix Feed Mill Projects
Dust system design is included in our standard process engineering scope — it’s not specified separately after the main equipment is laid out. The extraction points, suction volumes, duct sizing, and collector specifications are calculated based on the specific raw materials the client is processing, the building layout, and the local climate conditions.
For clients in high-humidity markets (Southeast Asia, West Africa, coastal South America), we specify bag materials and cleaning cycles differently than for dry-climate installations in Central Asia or the Middle East. A dust system that performs well in Kazakhstan will need different maintenance protocols in Indonesia. That’s the kind of detail that gets worked out during process design — not discovered after commissioning.
What should I look for when selecting a mixer for a premix feed mill — and can I use the same mixer I have for compound feed?
+
The short answer to the second question: no. Premix and compound feed have fundamentally different mixing requirements, and a mixer optimized for compound feed production will underperform on premix duty in ways that directly affect product quality. Using the same equipment for both is not a cost-saving measure — it’s a quality risk.
The reason comes down to what mixing actually needs to achieve in a premix context. In compound feed, you’re blending ingredients measured in kilograms with relatively similar bulk densities.
In premix, you’re distributing gram-level vitamin concentrates and trace minerals through a carrier at ratios that can span three orders of magnitude — and the finished product needs to be homogeneous enough that every kilogram of premix delivers the same nutritional specification. That’s a different engineering problem.
Why Horizontal Paddle Mixers Are Standard for Premix
The original text references drum mixers, but in practice the industry standard for premix feed mill applications is the horizontal paddle mixer (single-shaft double-blade or twin-shaft paddle configuration) — not a drum or tumble mixer. Here’s why:
| Mixer Type | Bulk Density Variation Handling | Friction & Heat Generation | Liquid Addition | Cleanability | Premix Suitability |
|---|---|---|---|---|---|
| Horizontal paddle mixer | Excellent | Low | Good — spray nozzles integrate easily | Good — full discharge door | ✓ Standard choice |
| Ribbon mixer | Good | Low-medium | Moderate | Moderate — ribbon geometry traps residue | ✓ Acceptable for simpler formulations |
| Drum / tumble mixer | Good for density variation | Very low | Good — large exposed surface | Poor — difficult to clean thoroughly | ⚠ Limited use; cleanout is problematic |
| Vertical mixer | Poor | Medium | Poor | Poor | ✗ Not suitable for premix |
| Compound feed paddle mixer | Good for kg-range ingredients | Medium | Limited | Standard | ✗ Insufficient accuracy for premix |
The horizontal paddle mixer handles materials with large bulk density variation — which is exactly what premix batches involve — while generating minimal friction heat. Heat buildup during mixing is a real concern for vitamin-active premix; fat-soluble vitamins begin to degrade at temperatures above 40°C, and a mixer that runs hot on long cycles will affect potency before the product reaches packaging.
The Five Selection Criteria That Actually Matter
① Ease of material addition and liquid compatibility
The mixer must accommodate both dry ingredient addition (from the batching system above) and liquid addition where formulations include choline chloride, liquid vitamins, or oil-based additives. Liquid addition ports with spray nozzle systems need to be integrated into the mixer design — retrofitting them afterward is rarely clean.
② Static charge elimination
Fine premix powders, particularly vitamin dusts and certain mineral compounds, generate static charge during mixing. Static causes particles to adhere to mixer walls and internal components rather than staying in the blend — which directly reduces homogeneity and creates residue that transfers to the next batch. Mixers for premix duty should include antistatic design features or grounding systems.
③ Mixing time vs. static arching
Longer mixing cycles don’t always improve homogeneity — and in premix, extended mixing time can cause static arching (ingredients clumping and bridging rather than flowing freely). The optimal mixing time for most premix formulations is 3–6 minutes. Beyond that, many formulations start to de-mix rather than continue improving. The mixer geometry should achieve target CV within that window.
④ Minimum internal surface area and component count
Every internal component — paddle shaft, bearings, support brackets — is a surface where residue accumulates. In premix, residue means cross-contamination between batches. The design principle is minimum internal parts, minimum surface area, and cleanout access that actually works in production — not just in the factory acceptance test.
⑤ Discharge door design — zero residue standard
This is non-negotiable for premix applications. The discharge door must run the full length of the mixer base, open completely, and leave no heel material in the mixer after discharge. Residue targets for premix mixers: <100g per ton of batch capacity. A mixer that leaves 300–500g/t of residue — acceptable in compound feed production — creates meaningful cross-contamination problems when the next batch contains a different vitamin or mineral profile.
Premix Mixer Specifications — RICHI Standard Configuration
| Specification | Range |
|---|---|
| Batch capacity | 250–2,000 KG |
| Motor power | 4–55 KW |
| Mixing uniformity (CV) | ≤5% standard; 2–3% typical in operation |
| Residue after discharge | <100 g/t |
| Mixing cycle | 3–6 minutes to target homogeneity |
| Material contact surfaces | 304 stainless steel throughout |
| Discharge door | Full-length, pneumatic, zero-residue design |
| Liquid addition | Integrated spray nozzle system (optional) |
| Shaft seal | Engineered for zero product leakage |
The Compound Feed Mixer Question — Why Shared Equipment Fails
To return to the opening question directly: using compound feed mixing equipment for premix production creates three specific problems that can’t be managed around:
- Accuracy — compound feed mixers are not calibrated or designed for the homogeneity CV required in premix; the finished product will show batch-to-batch variation in trace nutrient distribution
- Residue and cross-contamination — compound feed mixer discharge geometry leaves significantly more residue than premix specification allows; this residue appears in subsequent batches at uncontrolled concentrations
- Cleaning — compound feed mixers are not designed for the cleanout frequency that premix production requires between formulation changes; the internal geometry makes thorough cleaning impractical in a production schedule
The manufacturing standard for premix is different from compound feed — and the equipment needs to reflect that from the outset. It’s one of the first points we make to clients who ask whether they can adapt existing equipment rather than invest in a dedicated premix mixer.
How do you select the right carrier and diluent for a premix feed mill — and what goes wrong when the selection is poor?
+
Carrier and diluent selection is a formulation decision, but it has direct consequences for equipment performance and finished product quality — which is why we discuss it during the process design phase, not just leave it to the nutritionist.
A carrier with the wrong particle size or bulk density creates segregation problems that no mixer can fully correct. A diluent chosen purely on cost can cause nutritional imbalances in the finished compound feed. Both issues are avoidable if the selection criteria are applied correctly from the start.
Carriers vs. Diluents — What Each Does
| Carrier | Diluent | |
|---|---|---|
| Primary function | Physically carries and holds micronutrients (vitamins, trace minerals) on its surface | Amplifies or dilutes micronutrients; acts as flow agent and filler |
| Effect on premix | Determines particle distribution and active ingredient stability | Affects bulk density, flowability, and inclusion volume |
| Typical examples | Rice husk powder, corn cob meal, wheat bran, DDGS | Limestone powder (stone powder), zeolite powder, dicalcium phosphate |
| Key selection factor | Porosity, particle uniformity, surface area for active ingredient loading | Density compatibility with carrier; nutritional neutrality |
Carrier Selection — What Actually Matters
Rice husk powder is widely used as a premix carrier because its combination of particle uniformity, shape, and porosity makes it particularly effective at physically holding finely ground micronutrients without releasing them during handling and transport. The porous surface structure allows active ingredients to adhere rather than simply coat the surface — which reduces segregation during transfer and extends the effective shelf life of the finished premix.
Other commonly used carriers and their characteristics:
| Carrier | Key Properties | Common Applications |
|---|---|---|
| Rice husk powder | High porosity, uniform particle shape, low bulk density | Vitamin premix, compound premix — widely used in Asia |
| Corn cob meal | Good porosity, slightly coarser than rice husk | Compound premix, mineral premix in Americas and Africa |
| Wheat bran | Widely available, cost-effective, medium porosity | General compound premix; moisture management required |
| DDGS | Higher protein content, variable particle size | Specialty premix where protein carrier is acceptable |
| Soybean hull powder | Low bulk density, good flowability | Compound premix in markets with soy processing availability |
Particle size of the carrier is not negotiable. The target is a particle size range that gives the finished premix good flowability and low dust generation, while providing sufficient surface area to load active ingredients without causing segregation. When carrier particle size is too coarse relative to the trace mineral or vitamin being blended in, the active ingredient concentrates in the fine fraction — and the blend separates during handling before it reaches the end user.
Diluent Selection — The Cost Trap to Avoid
The original text raises a specific problem that’s worth stating clearly: using calcium carbonate (limestone powder) as a cost filler in premix — rather than for its functional properties — results in premix with a disproportionately high calcium content. When that premix is included in compound feed at standard rates, it pushes the calcium-to-phosphorus ratio out of balance, which directly affects animal performance. This is a documented problem in low-cost premix products from suppliers who optimize for margin rather than nutritional outcome.
The correct basis for diluent selection:
- Density compatibility with the carrier — large bulk density differences between carrier and diluent cause segregation during mixing and transport; the angle of repose and bulk density of the two materials should be measured and matched
- Nutritional neutrality — the diluent should not contribute nutrients at levels that distort the finished compound feed formulation when premix is included at specification rate
- Flowability — diluents that pack or bridge in storage bins create batching problems at the micro-dosing stage; zeolite powder and limestone powder both have different flow characteristics that affect how they behave in the dosing system
- Compatibility with active ingredients — some diluents interact with specific vitamins or minerals; this needs to be checked against the formulation before selection is finalized
The Segregation Problem — Why Particle Size and Bulk Density Both Matter
Segregation is the enemy of premix homogeneity — and it happens after mixing, not just during it. A premix that tests at CV <5% leaving the mixer can arrive at the farm with active ingredients concentrated in the fine fraction at the bottom of the bag. Two physical properties drive this:
① Particle size difference:
When carrier and active ingredient particle sizes differ significantly, larger particles travel farther during vibration and handling — they migrate to the edges and top of the bag while fines concentrate at the bottom. The closer the particle size match between carrier and active ingredients, the more stable the blend remains during transport.
② Bulk density difference:
Large variations in bulk density between ingredients cause denser particles to settle relative to lighter ones during handling. This is why the combined application of carrier and diluent is specified — the combination is designed to achieve a target finished premix density that minimizes settling during transport and storage.
Practical check: Flowability of a raw material or finished premix can be assessed by measuring the angle of repose. A lower angle of repose indicates better flowability and lower segregation tendency. We use this measurement when evaluating carrier-diluent combinations for clients whose raw material supply varies seasonally.
How This Affects Equipment Design in a Premix Feed Mill
Carrier and diluent selection affects the premix feed mill equipment specification in three direct ways:
- Storage bin design — carriers with high moisture absorption (rice bran, wheat bran) require sealed bins with anti-bridging agitators; zeolite diluents have different flow properties that affect hopper angle requirements
- Conveying system — bulk density variation between carrier and diluent affects screw conveyor sizing and speed; a conveyor calibrated for limestone powder will not handle rice husk powder at the same throughput
- Mixer residence time — the target mixing time is set based on the specific carrier-diluent combination; different combinations reach homogeneity at different cycle lengths
This is why we request the client’s intended carrier and diluent specification before finalizing equipment selection — not after. The physical properties of these materials shape the equipment configuration in ways that can’t easily be corrected once manufacturing begins.
What does a premix feed mill need to consider when developing a premix formulation — and where do most formulation problems actually come from?
+
Formulation development for premix is specialist work — it requires a trained nutritionist or formulation chemist, not just someone familiar with compound feed recipes.
The original text makes a point worth stating directly: many premix formulation problems come from the formulator’s personal bias or incomplete understanding of ingredient interactions, not from equipment failure. A well-engineered premix feed mill processing a poorly developed formula will still produce a poor product.
As equipment engineers, formulation is the client’s domain — we don’t write premix specifications. But after working through hundreds of premix projects and reviewing clients’ raw material lists and formulations during process design, we’ve developed a detailed understanding of what formulation decisions affect equipment performance, ingredient handling, and finished product stability. That’s the lens through which we discuss formulation here.
What a Premix Formulator Must Evaluate Before Writing a Specification
The original text identifies the core variables correctly. In practice, these need to be evaluated in a specific sequence:
| Evaluation Step | What It Involves | Why It Matters for Equipment |
|---|---|---|
| Raw material sourcing | Supplier consistency, country of origin, batch-to-batch variation | Inconsistent raw material specs require adaptive batching calibration |
| Specific gravity & particle size | Bulk density measurement, sieve analysis of each ingredient | Determines mixer configuration, conveying design, segregation risk |
| Processing characteristics | Flowability, hygroscopicity, bridging tendency, corrosivity | Affects storage bin design, dosing system selection, contact surface material |
| Ingredient interactions | Chemical compatibility between vitamins, minerals, and carriers | Determines mixing sequence, pre-blending requirements, storage segregation |
| Nutrient availability | Bioavailability of vitamin and mineral forms by source | Affects inclusion rate calculation and overage specification |
| Cost vs. function | Cost optimization within nutritional and processing constraints | Should never override functional requirements — see carrier/diluent note |
Nutrient Availability — The Variable Most Formulators Underestimate
Vitamin and trace mineral bioavailability varies significantly depending on the chemical form and source — not just the declared potency on the certificate of analysis. Two vitamin E products at the same IU/g declaration can have meaningfully different in-vivo efficacy depending on whether they’re dl-alpha-tocopheryl acetate (synthetic) or d-alpha-tocopheryl acetate (natural source). Similarly, organic trace mineral forms (amino acid chelates) have higher bioavailability than inorganic sulfate forms at the same declared mineral content.
For standard commercial premix, this distinction is often absorbed into standard inclusion rate tables. For high-grade premix — breeder premix, aquaculture specialty premix, pharmaceutical-grade animal health premix — the source and form of each active ingredient needs to be specified explicitly, not left to whatever the supplier ships.
Vitamin Stability — Six Strategies Used in Practice
Vitamin stability is the formulation challenge most specific to premix production. Unlike trace minerals, vitamins degrade during storage, processing, and even during mixing if conditions aren’t controlled. The original text identifies six practical strategies:
① Synthetically stable vitamin derivatives
Using chemically stabilized forms (e.g., vitamin C as L-ascorbyl-2-monophosphate rather than ascorbic acid) extends shelf life significantly — particularly important for aquatic premix where vitamin C degradation in storage is a real production challenge.
② Addition of stabilizers / antioxidants
Ethoxyquin, BHA, and BHT are used in some formulations to protect fat-soluble vitamins from oxidative degradation. Note: antioxidant use has regulatory restrictions in some markets (EU has phased out ethoxyquin in feed); confirm local requirements before specifying.
③ Microencapsulation / coating
Coated vitamin forms protect active ingredients from moisture, oxygen, and pH effects during mixing and storage. Coating adds cost but extends declared shelf life and protects potency through the feed manufacturing process downstream.
④ Liquid vitamin absorption onto carrier
Fat-soluble vitamins in liquid form (vitamin A, D, E oils) are absorbed onto a suitable dry carrier before entering the main batching system. This converts them to a free-flowing powder form that doses accurately and distributes evenly in the mixer.
⑤ Water-soluble and water-dispersible vitamin forms
For premix going into aquatic feed or liquid supplement applications, water-dispersible forms of fat-soluble vitamins ensure they distribute properly when the finished feed contacts water.
⑥ Overage specification (2–10% above label claim)
Because vitamin potency degrades over the shelf life of the premix, formulators specify an overage — producing at 102–110% of the label claim at time of manufacture so the product still meets specification at end of shelf life. The overage percentage is calculated based on the vitamin’s half-life under expected storage conditions, the declared shelf life, and the storage environment (temperature, humidity).
Interaction Effects — What Goes Wrong When Compatibility Isn’t Checked
The most common ingredient interaction problems in premix formulation:
| Interaction | Effect | How to Manage |
|---|---|---|
| Choline chloride + fat-soluble vitamins | Choline chloride is hygroscopic and corrosive; degrades vitamins A, D, K in direct contact | Add choline chloride separately; do not pre-mix with fat-soluble vitamins |
| High copper + vitamin E | Copper acts as a pro-oxidant; accelerates vitamin E degradation | Separate storage; minimize contact time in mixer via sequenced addition |
| Selenium (sodium selenite) + vitamin C | Ascorbic acid reduces selenite to elemental selenium, reducing bioavailability of both | Use stabilized vitamin C forms; sequence addition to mixer |
| Mineral sulfates + vitamin B1 (thiamine) | Sulfate ions accelerate thiamine degradation in humid conditions | Keep moisture <10% in finished premix; use coated thiamine |
These interactions are not theoretical — they show up as potency failures in quality testing, typically discovered at the end of the shelf life when the product has already been distributed. The correct point to address them is during formulation development, not after the premix feed mill is commissioned.
What This Means for Equipment Design
Formulation decisions feed directly into equipment specification:
- Choline chloride added separately → requires a dedicated addition port on the mixer, separate from the main batching circuit
- Liquid vitamin absorption required → requires a liquid addition system and possibly a pre-blending unit upstream of the main mixer
- Coated vitamin forms → lower-shear mixing protocols to avoid breaking the coating during the mix cycle
- High overage spec on heat-sensitive vitamins → mixing temperature monitoring and shorter cycle times to limit heat exposure
This is why we ask for the client’s formulation list — or at least the ingredient categories and any known compatibility constraints — before finalizing the equipment design. A premix feed mill built without that information will run, but may not protect the formulation it’s processing.
How do you evaluate whether a premix feed mill investment is actually optimized — and where do most buyers get the calculation wrong?
+
Most buyers evaluate premix feed mill investment by comparing equipment purchase prices. That’s the wrong metric. The correct measure of investment optimization is the total cost of production over the equipment’s operational life — and that calculation looks very different from the upfront capital comparison.
The formula that matters:
Total production cost = Equipment depreciation + Labor + Energy consumption + Maintenance
Two failure modes are common in premix feed mill investment decisions, and both are more expensive than a well-structured investment:
| Failure Mode | What It Looks Like | Actual Outcome |
|---|---|---|
| Low capital, high operating cost | Cheap equipment, manual processes, low automation | Looks affordable at purchase; labor and energy costs accumulate to far exceed the capital saving within 3–5 years |
| High capital, high operating cost | Expensive equipment chosen incorrectly for the production scale | Over-specified in some areas, under-specified in others; still inefficient to run |
Neither reaches the minimum total production cost. The optimal investment is the configuration where the sum of depreciation + labor + energy + maintenance is lowest over the equipment’s working life — typically calculated over 10 years.
Two Processes Where Investment Optimization Has the Most Impact
① Raw Material Feeding / Intake Process
Manual bag-breaking and feeding is the default in many smaller premix operations because the equipment cost is zero. The labor cost over time is not.
Using a 100 t/day intake capacity as the reference point, calculated over a 10-year depreciation horizon:
| Feeding Method | Equipment Investment | Annual Labor Requirement | 10-Year Total Cost Comparison |
|---|---|---|---|
| Manual bag-breaking | $0 equipment | 3–4 operators per shift | High — labor cost accumulates significantly |
| Automatic bag-breaking / unpacking machine | $15,000–$40,000 | 1 operator supervision | Low — equipment depreciation + minimal labor |
The result: Automatic unpacking equipment, compared to manual feeding at equivalent throughput, saves several hundred thousand dollars over a 10-year horizon in most labor markets — even accounting for maintenance and depreciation. In markets with higher labor costs (Europe, North America, Australia), the payback period on automated feeding equipment is typically under 18 months.
Beyond cost, manual bag-breaking at fine powder intake points creates significant dust exposure for operators — which has both occupational health and regulatory compliance implications that don’t appear in a simple cost comparison.
② Packaging Process
The packaging stage offers the clearest illustration of investment optimization in a premix feed mill because three automation levels exist with measurable cost differences across all four cost categories.
Reference scenario: 15 t/h premix feed mill capacity, 25 kg per bag, 4,800 bags per shift, required packaging speed 600 bags/hour, 10-year equipment depreciation basis.
| Packaging Method | Equipment Investment | Operators Required | Throughput Reliability | 10-Year Total Cost |
|---|---|---|---|---|
| Manual packaging | Minimal | 4–6 per line | Variable — fatigue affects speed and weight accuracy | Highest |
| Semi-automatic packaging | $20,000–$60,000 | 2–3 per line | Consistent — operator loads bags, machine fills and weighs | Medium |
| Fully automatic packaging line | $60,000–$150,000 | 1 operator supervision | Highest — consistent speed, weight accuracy, bag sealing | Lowest over 10 years |
The result: Both semi-automatic and fully automatic packaging configurations save several hundred thousand dollars over 10 years compared to manual packaging at 15 t/h scale — the exact figure depends on local labor rates, shift structure, and packaging volume. In high-labor-cost markets, the fully automatic line pays back its capital premium over semi-automatic within 2–3 years. In lower-labor-cost markets, semi-automatic is often the optimal balance point.
Weight accuracy is the other variable that doesn’t appear in a cost table: manual packaging at 600 bags per hour produces measurable weight variation that represents product giveaway — consistently packing 26kg into a 25kg bag across 4,800 bags per shift adds up to meaningful product loss per year.
The Investment Optimization Framework — Applied Across the Full Line
The feeding and packaging processes are used here as examples because the numbers are easy to illustrate. The same analytical framework applies to every stage of premix feed mill design:
- Batching system: Manual weighing vs. semi-auto vs. fully automatic — labor cost per batch, accuracy-related waste, and production rate all factor into the 10-year calculation
- Conveying system: Manual transfer vs. pneumatic or mechanical conveying — labor elimination and cross-contamination risk reduction both have financial value
- Dust collection: Adequate vs. undersized — undersized systems increase maintenance frequency, create occupational health liability, and result in product loss through fugitive dust
- Control system: Basic PLC vs. full SCADA — the value of batch traceability and recipe management shows up in quality consistency and regulatory compliance, not just in direct operating cost
What Most Premix Companies Get Wrong at the Design Stage
The original text identifies this directly: most premix operations make equipment selection decisions without comparative analysis of production costs under different configurations. They compare purchase prices, not 10-year total costs. The result is a line that looks like a cost-effective investment at commissioning and becomes an increasingly expensive one to operate as labor costs accumulate and cheap components require more frequent maintenance.
The analysis we provide during process design — before any equipment is specified — includes a production cost comparison across different automation configurations for the client’s specific output target, local labor rates, and energy costs. The goal is to identify the configuration where total 10-year cost is minimized, not where purchase price is minimized. Those are often different answers, and understanding why is the starting point for a well-structured premix feed mill investment.
What raw material quality standards should a premix feed mill apply when sourcing ingredients — and what are the most common quality failures?
+
Raw material quality determines premix product quality more directly than any piece of equipment in the line. A premix feed mill with excellent batching accuracy and mixing uniformity will still produce a substandard product if the incoming raw materials don’t meet specification.
This is a procurement and quality management issue as much as a production issue — and it’s one where corner-cutting has consequences that show up in animal performance data, not on the production floor.
The baseline requirement for all premix raw materials: high active ingredient purity, absence of toxic and harmful substances, and physical properties that are stable and consistent across supply batches. Beyond that baseline, different ingredient categories have specific quality criteria that need to be evaluated separately.
Quality Criteria by Ingredient Category
① Vitamin Raw Materials — Stability is the Core Issue
Vitamins are the most quality-sensitive ingredients in any premix formulation. Declared potency on a certificate of analysis reflects the product at time of manufacture — not necessarily at time of use.
| Vitamin | Key Quality Concern | What to Verify |
|---|---|---|
| Vitamin A | Oxidizes rapidly; potency loss accelerates with heat, moisture, and trace metal exposure | Actual assay at time of receipt, not just CoA date; encapsulation quality |
| Vitamin C (ascorbic acid) | Most unstable vitamin in standard form; degrades in presence of moisture and oxygen | Verify form (ascorbic acid vs. stabilized phosphate ester); actual potency by HPLC |
| Vitamin E | Fat-soluble; susceptible to rancidity in presence of unsaturated fats | Peroxide value of the carrier fat; storage temperature history |
| Fat-soluble vitamins (A, D, E, K) | All sensitive to heat, light, and oxidation | Packaging integrity; cold chain compliance where applicable |
| B-complex vitamins | Variable stability; B1 (thiamine) and B9 (folic acid) particularly sensitive | Moisture content of incoming material; storage humidity records |
Critical point: For vitamin A and vitamin C specifically, declared content on the supplier’s certificate is insufficient. Actual potency should be verified by independent measurement — these two vitamins are most commonly found to be below declared specification in market surveys of premix raw materials. Inclusion rates in the formulation should be set based on actual measured potency, not label claim.
② Trace Element Raw Materials — Four Factors to Evaluate
Trace element quality evaluation is more complex than vitamin evaluation because the relevant quality parameters span chemistry, physics, and toxicology simultaneously.
The four factors that must be assessed for every trace element raw material:
| Factor | What It Affects | Evaluation Method |
|---|---|---|
| Active ingredient content | Bioavailable mineral delivered per kg of raw material | Chemical assay; compare to declared content |
| Particle size | Blending uniformity with carrier; segregation tendency | Sieve analysis; d50 measurement |
| Crystal water content | Actual mineral content vs. declared (hydrated forms contain water by weight) | Thermal gravimetric analysis; verify anhydrous vs. hydrated form |
| Toxic and harmful substance levels | Heavy metal contamination (lead, arsenic, cadmium, mercury) in mineral compounds | ICP-MS analysis; particularly important for zinc, copper, and manganese sources |
Biological potency is the additional variable for organic trace mineral forms (amino acid chelates, proteinate forms). Organic minerals command a price premium specifically because of higher bioavailability — but bioavailability claims vary significantly between suppliers and need to be verified against published research or in-house trial data, not accepted at face value from the supplier.
③ Feed Additive and Functional Ingredient Raw Materials
This category covers enzymes, probiotics, acidifiers, phytogenics, and other functional additives that appear at very low inclusion rates in compound premix formulations.
Key quality considerations:
- Dosage form compatibility: Some additives in liquid form, powder form, or coated form interact differently with other ingredients in the premix. The dosage form affects both stability and how the ingredient behaves in the mixing and conveying system.
- Interaction effects with other additives: Certain combinations — acidifiers with buffering minerals, coccidiostats with specific ionophores, enzymes with oxidizing compounds — reduce the efficacy of one or both components. This needs to be mapped against the full formulation before purchase decisions are made.
- Inclusion rate precision: At very low inclusion rates, potency variation between batches of the same additive has a proportionally larger effect on the finished premix than it would at higher inclusion rates. Tight specification limits and incoming quality testing are more important, not less, for low-inclusion functional ingredients.
④ Medicated Feed Additives — Regulatory and Safety Requirements
Medicated additives in premix require a separate quality management track from nutritional ingredients:
- Withdrawal period compliance: Each medicated additive has a specified withdrawal period before slaughter. The premix feed mill must maintain records of which batches contain medicated additives and which downstream feed products they were used in — traceability is a regulatory requirement in most markets, not optional.
- Use period and dosage: Manufacturer instructions on usage period, target species, and maximum inclusion rate are not suggestions. Exceeding specified dosage creates residue risk in animal products and potential regulatory violation.
- Incompatibility with other medications: Certain drug combinations are contraindicated. This requires active management of which medicated premix formulations are produced on the line and in what sequence — cleanout between incompatible formulations is a compliance requirement.
How Raw Material Quality Affects Equipment Specification
Raw material quality variability has direct consequences for premix feed mill equipment performance:
| Raw Material Quality Issue | Equipment Impact |
|---|---|
| High moisture content in carrier | Bridging in storage bins; dosing accuracy drift; requires anti-bridging systems |
| Variable particle size batch-to-batch | Segregation in conveying; inconsistent mixer residence time to homogeneity |
| High crystal water in mineral salts | Batching weight calculation error if not accounted for in recipe management |
| Hygroscopic additives | Caking in micro-dosing hoppers; requires sealed storage and agitation |
| Low-bulk-density vitamin powders | Requires low-velocity pneumatic conveying to prevent separation from carrier |
This is why incoming raw material specification is part of our process design conversation — not something we leave entirely to the client’s procurement team. Knowing what the raw materials actually look like physically, not just what the CoA says, shapes the equipment configuration in ways that matter for long-term production performance.
The Practical Approach to Raw Material Quality Management
For a premix feed mill starting production, the minimum quality management framework should include:
- FIFO stock rotation — first-in-first-out management to prevent potency degradation in slow-moving vitamin stocks
- Incoming inspection protocol — weight verification, visual inspection, moisture check, and CoA review for every delivery
- Periodic independent testing — third-party laboratory analysis of vitamin potency and trace mineral content at defined frequency (monthly for high-volume ingredients; per-batch for critical low-inclusion vitamins)
- Approved supplier list — qualification of raw material suppliers against defined quality standards before they enter the supply chain, not after a quality failure
Segregated storage by ingredient category — vitamins stored separately from minerals; medicated additives stored and handled on a separate documented track
Why isn’t there a standard premix feed mill process design — and what information do I need to prepare before contacting RICHI for a quote?
+
The direct answer: because the variables that determine how a premix line should be designed are specific to each project, and combining them differently produces a different optimal process every time. A process that works correctly for one client’s raw materials, building, budget, and production targets will be wrong — not just suboptimal, but functionally wrong — for another client’s situation.
The factors that make every premix feed mill design unique:
| Variable | Why It Changes the Process Design |
|---|---|
| Raw material variety and source | Different carriers, mineral forms, and vitamin sources have different particle sizes, bulk densities, flowability, and handling requirements — the equipment that handles rice bran correctly won’t handle limestone powder the same way |
| Formulation type and complexity | A single-product vitamin premix line looks nothing like a multi-species compound premix line; the number of dosing stations, mixer type, and batching sequence all differ |
| Production variety (SKU count) | Running 3 formulations requires different changeover protocol design than running 30 formulations on the same line |
| Raw material intake method | Bulk truck receiving vs. bag-breaking station vs. super-sack unloading — each requires different receiving infrastructure |
| Building height and floor area | Ceiling height determines whether a vertical gravity-flow layout is possible; floor area constrains equipment arrangement options |
| Capital budget | Automation level, materials of construction, and redundancy provisions are all calibrated to budget — the goal is optimal investment, not maximum specification |
There is no standard perfect process. What exists is a correctly designed process for each specific project — and that design requires real project information to produce.
What RICHI Can Help With — Across All Project Types
Whether you’re evaluating a modular premix feed mill for a farm operation or planning a new industrial-scale facility, the starting point is the same: a technical consultation based on your actual situation. All equipment is designed and manufactured to meet individual project requirements — not configured from a fixed catalog.
Three types of enquiries we handle:
① Complete premix feed mill project
Full scope from process design through commissioned production line. This covers new builds, retrofits of existing feed facilities, and capacity expansions.
Information needed to prepare a meaningful proposal:
- Raw material types and availability (carrier material, vitamin sources, mineral compounds, functional additives)
- Required output capacity (t/h) and daily/annual production target
- Premix types to be produced (vitamin premix, mineral premix, compound premix, medicated premix — and whether multiple types will share the line)
- Process technology preferences or constraints (automation level, stainless steel specification, GMP requirements)
- Building dimensions and height, or site area if new construction
- Budget range and financing structure
- Estimated project start date and commissioning target
② Individual premix feed mill machinery
Single equipment replacement, capacity addition, or specific component procurement.
Information needed:
- Equipment type and model reference (if known)
- Required capacity and throughput
- Interface specifications (inlet/outlet dimensions, connection points to existing line)
- Budget parameters
- Any specific material or certification requirements
③ Spare parts
Replacement components for existing RICHI equipment or compatible third-party equipment.
Information needed:
- Component dimensions and specifications
- Material grade (stainless steel specification if applicable)
- Weight and connection details
- Engineering drawings where available — send to: enquiry@richipelletmachine.com
Why Detailed Information Produces Better Proposals
A vague enquiry (“I want a 5 t/h premix line, what’s the price?”) produces a vague response — a wide price range that doesn’t help you make a decision. A detailed enquiry produces a specific proposal: itemized equipment list, process flow matched to your raw materials and building, and a cost figure you can actually use for investment planning.
The time spent preparing project information before contacting us is recovered immediately in the quality of the proposal you receive back. Clients who provide complete project details in their first enquiry typically receive a full technical proposal and cost estimate within 3–5 business days. Clients who provide incomplete information go through multiple rounds of clarification before a meaningful proposal can be produced — which delays the project and occasionally leads to equipment being specified incorrectly.
This is not a sales pitch for thoroughness. It’s an engineering reality: a premix feed mill designed without accurate input data will be optimized for the wrong project.
